Title: Twelfth Period Award Fee Evaluation International Space Station Contract NAS 1510000
1Twelfth Period Award Fee EvaluationInternational
Space StationContract NAS 15-10000
-

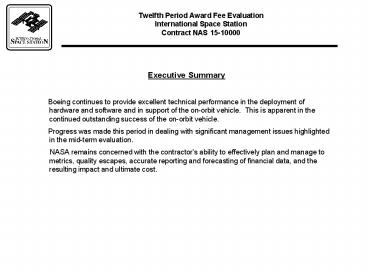

- Executive Summary
- Boeing continues to provide excellent
technical performance in the deployment of
hardware and software and in support of the
on-orbit vehicle. This is apparent in the
continued outstanding success of the on-orbit
vehicle. - Progress was made this period in dealing with
significant management issues highlighted in
the mid-term evaluation. - NASA remains concerned with the contractors
ability to effectively plan and manage to
metrics, quality escapes, accurate reporting and
forecasting of financial data, and the resulting
impact and ultimate cost.
2- Twelfth Period Final Evaluation
- International Space Station
- Contract NAS 15-10000
- April 2002
3Twelfth Period Award Fee Evaluation International
Space Station Contract NAS 15-10000
- A. Program Management
-
- Summary
- The contractor has implemented a process for
managing and tracking the IO activity and
continues to implement improvements to the
process. The contractor has been aggressively
managing work package adjustments as well as
expedited approval of certain urgent change
proposals. Through this period the truss
activity and, in general, proactive truss
schedule management has been a significant
weakness. The contractor has recognized this and
has updated the S1/P1 schedules and reorganized
the element teams. Additionally, cost reporting
has been a serious weakness this period. - Strengths
- The contractor developed and implemented an IO
management process (WPRR) and continues to
develop improved processes for increased insight
into the day to day implementation of IO work
content and for increased efficiencies in
management of IO content. - An outstanding scheduling process was put in
place at KSC that accurately portrays work
content for a given day, tracks progress daily
and incorporates problems encountered. It is
used for analyzing the critical path and deriving
metrics for management review. Implementation of
the scheduling process has resulted in
significant progress toward effective and
efficient planning of work activities and
resource utilization on S1/P1. - Realignment and augmentation of the management
teams at KSC for both the inboard and outboard
truss teams has resulted in improved focus and
insight into resolution of processing challenges
and problems. Additionally, the staffing of
distinct truss teams, down to the QA / technician
level, has resulted in improved continuity and
overall ownership by the teams. - The Avionics and Software team has been very
proactive in preparing for consolidation of
tasks, such as in aggressive hiring of
critical skills and transfer of contracts. This
is expected to result in a smooth transition of
tasks from HB and CP to Houston.
A - 1
4Twelfth Period Award Fee Evaluation International
Space Station Contract NAS 15-10000
- A. Program Management
-
- Strengths (cont.)
- Boeings continued proactive participation in the
Integrated Program Schedule Panel (IPSP) has been
exceptional as a result of experienced personnel
assignments in the software scheduling area. The
Software Plan to launch, which is now being
statused weekly at the IPSP, is an example of the
result of these assignments. - Boeing developed a new product to facilitate
accurate and timely annual property NF-1018
reporting by incorporating their own internal
form called a BF-1018. The BF-1018 has more
specific property reporting instructions, which
resulted in a more accurate and timely NF-1018
submittal. Boeing's submittal of the NF-1018 for
'01 has been the most accurate property report
under the contract to date, as evidenced by
feedback from JSC's financial management office.
In addition, the first on-orbit property report
was outstanding. - Boeing contracts did an outstanding job of
turning around urgent proposals when Authority to
Proceed was needed quickly. Ninety days are
normally allowed to build a proposal, however,
SSCNs 4407, 5936, 5949 and 4823 were developed in
significantly less time. In addition, the
contractor was instrumental in finalizing
paperwork and negotiations to meet the short time
constraints. - Weakness
- The contractor has not been able to adequately
portray the financial posture of the baseline
contract. Presentations at the Space Station
Program Control Board (SSPCB) , Cost, Schedule,
Technical Reviews (CSTRs), and Quarterly Program
Manager Reviews do not clearly define key
management metrics, such as fiscal year reserves
and performance issues, and provide no summary
perspective or conclusions regarding the fiscal
posture. In numerous instances, the contractor
could not explain the data being presented and
actual data and information were not in sync with
forecasts. Additionally, the quality and
consistency in detailed presentations vary widely
across Super Cost Account Managers
A-2
5Twelfth Period Award Fee EvaluationInternational
Space StationContract NAS 15-10000
- Program Management (cont.)
- Weaknesses (cont.)
- Boeing technical offices are not adequately
supporting the change proposal process. Examples
include - Recent LKP data delivery dates (I.e. 5046 5811)
continue to slip. - In some cases, NASA has begun negotiations based
on proposal data, only to be informed that actual
work costs are already in excess of proposal data
before negotiations even begin. - Planning and scheduling of required work to
support definitization by the required
authorization to proceed (ATP) date particularly
in the area of external carriers. - In a formal audit, DCAA found Boeings estimating
system to be inadequate in part in the area of
subcontract and material costs. Although the
contractors response previously indicated that
all corrective actions had been completed, NASA,
DCAA, and the DCMA were not satisfied that
adequate training had been provided. Since that
time, Boeing has established an adequate
corrective action plan. DCAA intends to monitor
the effectiveness of the training by auditing
proposals over the next few months. - In a formal audit, DCAA found Boeings Billing
System to be inadequate in part. Furthermore,
NASA requested a supplemental audit because of an
over billing of 46M in November 2001. NASA
requested that DCAA perform quarterly voucher
reviews as a result. Boeing is cooperating with
NASA to resolve this issue and has an adequate
corrective action plan in place. - The contractor did not manage the S0 truss
activity effectively. Significant management and
performance issues on S0 impacted S0 and
downstream truss schedules and resolution was not
proactive or timely and resulted in additional
Program cost.
A-3
6Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B. 1 Vehicle Hardware Production
- Summary
- The contractor has exhibited improved
performance in development and final assembly of
the truss elements through incorporation of
several process improvements. Additionally,
preparation and support of FCAs and ARBs
continues to be a strength through this period.
However, slow closure of engineering paper
against the elements continues to be a
significant concern relative to the ability to
maintain a full understanding of the effort to
complete each element. - Strengths
- Boeing support of FCA and ARB milestone
activities continues to be a strength. During
this period the P3/S3 and P5/S5 FCAs were
completed. Also, P4/S4, P5, and P1/S1 ARBs were
completed and the elements DD250d. - The contractor has done an outstanding job of
applying lessons learned from earlier missions to
assembly tasks on 9A, 11A, 12A and 13A resulting
in improved schedule performance and fewer PRs - Added assembly drawing notes to streamline the
resolution of dents/dings/scratches - Revised the shroud fit-check process to include
onsite thermal support and buy-in - P4 MT rail fit-up and match drilling
- Solar array wing buildup
- P3/S3 MLI shroud fit checks
- The Contractor has implemented process
improvements to streamline flight preparation of
truss elements - Significantly streamlined ground processing
activities through the implementation of the
Discrepancy Report system to expedite minor
repairs and return-to-print anomalies. - Implemented a new process by which shroud
modifications can be performed without class 1
control or Configuration Management tracking. - Developed a method to install the S1 and P1 Pump
Module Assemblies (PMA) and Crew Equipment
Translation Aid (CETA) carts in the Space Station
Processing Facility (SSPF), thereby eliminating
the need to return to the Operations and Checkout
(OC) building.
B.1-1
7Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B. 1 Vehicle Hardware Production
- Strengths (continued)
- Boeing EVR team did a notable job in the DDTE of
the Camera Berthing and Centerline System. The
technical products met the aggressive schedule to
ensure that only minor schedule impacts were seen
in the MBS ground processing at KSC. - The Structure and Mechanisms team has done an
outstanding job of completing the work on MCASS,
PAS, CAS and the test tool PCAS. The completion
of the work on MCASS was schedule critical and
the team met critical milestones. - The contractor has done an outstanding job of
accommodating new or unplanned work on S0 and the
Mobile Transporter and still maintain Program
milestones. These new or unplanned items were
due to several factors that included requirement
changes, problem reports taken during processing,
and hardware design or manufacturing issues.
Some examples include reworking of the Mobile
Transporter captive nut retainers with no
significant impact to the Ready for Shuttle
Integration date and reworking of the fluid
umbilical multilayer insulation blankets without
any impact to the Installation into the Canister
date. - The contractor has done a notable job of
performing planned work earlier than scheduled to
ensure the work does not affect the critical
path. Some examples of this include the SVS
target installations and surveys, handrail label
installations, flight cover removals in the OC
building versus at the Pad, and completion of 13
S1 QD leak checks to support S0 problem
resolution. - The contractor did an outstanding job
coordinating and executing the Passive Common
Attach Mechanism interface test with the Mobile
Base System (MBS) Common Attach System (MCAS).
The hardware arrived early at KSC and the test
was completed on time. No anomalies were noted
during the test. No retesting had to be
performed. The management of the test was
outstanding.
B.1-2
8Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B. 1 Vehicle Hardware Production
-
- Strengths (continued)
- The Boeing Outboard Truss test team continues to
perform exceptionally well. Their methodology
for team make-up, procedural/test script
development, dry-running procedures with
high-fidelity test equipment, effective use of
lessons learned, and test execution is
outstanding. During this period the Outboard
Truss test team successfully completed the P4 and
S4 command and response tests and the functional
checkout of the two 12A flight wings ahead of
schedule and without ANY Problem Reports (PR)
taken or procedural deviations required. - Weaknesses
- The contractor continues to defer paper closure
until late in the processing flow, causing a
large commitment of resources at that time and
increasing the risk that open issues will not be
identified early enough to minimize impacts to
element flow. - Inadequate performance associated with open paper
closure forced rescheduling of the Flight 8A LPA
from 12/18/01 to 01/29/02. - Truss elements S1 and P1 (Flights 9A, 11A) have a
combined 1369 post-ARB open items documented in
OPMT as of 3/18/02, including approximately 606
KSC items. - Significant amount of S0 open paper encountered
at both LPA and SORR, requiring significant
efforts at end of process which increases both
risk and cost to the Program. - KSC build books and open paper closures were not
maintained as current, resulting in closure
inefficiencies which cost the Program.
B.1-3
9Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B. 1 Vehicle Hardware Production
- Weaknesses (cont.)
- The contractor needs to focus more attention on
ensuring quality procedures, training, attention
to detail and workmanship in the development of
flight hardware. Examples of problems associated
with these items include - S0 problems (1) Improper 1-g Umbilical
installation, (2) Inadvertent loading of MT by
Zero-g Support Equipment (ZSE) during
MT-to-S0 mate, (3) Use of silver-plated
fasteners, (4) Improper installation of umbilical
thermal blankets, (5) Click Bond installation
failures. - During the removal of quick disconnect (QD) 164
from the P1 truss, the contractor failed to
follow approved procedure and established flight
cleanliness requirements by using a red hacksaw
to remove the QD. The recovery effort associated
with this failure has been very costly. - The contractor failed to implement established
program cleanliness practices and quality control
in manufacture of the Pump Module Assembly (PMA)
test stands for P1 and S1 in MEIT. A foam plug
intended to prevent contamination during welding
procedures was left in a line resulting in foam
particles throughout much of the plumbing. In
addition, the heat exchanger used during the test
was not properly passivated, resulting in
corrosion and subsequent contamination of the
loop. - Boeing failed to direct their contractor
(Parker-Symetrics) to update the Internal Self
Sealing Quick Disconnect Acceptance Test
Procedure (ATP) which was mandated by SSCM 4879.
Boeings failure to direct Parker-Symetrics
resulted in several hundred QDs delivered to
NASA with inadequate leak testing. - The contractor is still lacking in the planning
and coordination of Cargo Element envelope
checks. 8A DPA measurements remaining to be
taken, as well as the results of those which have
been, are not being reported to Boeing KSC. -
B.1-4
10Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B. 1 Vehicle Hardware Production
- Weaknesses (cont.)
- Although improving, Boeing continues to be slow
to identify and/or resolve significant hardware
issues. Examples include - An on-orbit failure of the Launch to Activation
(LTA) heater thermostats during the 5A mission in
early 2001 remained an open issue for S0 late
into the 8A Processing Flow. - The contractor missed the latching motor valve
from the QPIP 1459 corrective action
investigation and forced last minute engineering
analysis to fly as is with accepted risk. - Late identification of Mated QD Hydraulic Lockup
issue resulted in impacts to 8A LPA, turnover to
Shuttle, and SORR. - In the area of Inboard Truss testing, The
contractor needs to focus more attention on
ensuring quality procedures, training, and
attention to detail in preparing for and
implementing testing. Examples include - Revision C of the P1 TRD had been released and no
updates or hand writes to the P1 P1000 or P1100
procedures written to Revision B requirements had
been incorporated into the procedure. - AT P1000 and P1100 Test Readiness Reviews,
schedules were not provided and test
configuration specific exceptions to the
referenced drawing were not documented. - Boeing missed testing the 8A MBSU S0-1A/1B RBI 11
output copper path which provides primary power
to the Node 2 DDCU (N2NAD-1B) even though it was
in the procedure. Boeing has reviewed part of
the root cause and has taken action to resolve.
B.1-5
11Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B.2 Technical Performance - Avionics and
Software Production -
- Summary
- The contractors performance in the avionics
and software areas has been solid this period.
Major strengths included SSMMU delivery, 8A
transition, and improved PR cycle times.
Although improving, ECZ and CCS software schedule
performance remains a major problem. - Strengths
- The Boeing support to the CDH Hardware Team has
continued to be outstanding. All SSMMU sets
were delivered eight months ahead of the
pre-6A implementation schedule and all on-board
Command and Control MDMs and Payload MDMs were
upgraded with the SSMMU. This completes the
on-board mass memory upgrade effort. - Boeings support for the successful 8A software
on-orbit transition was outstanding, adding
functionality to CC, GNC, PEP, and ECZ. A very
effective Software Transition Readiness Review
preceded this milestone. - The prime instituted several valuable process
improvements - The average flow time for PRs in analysis was
reduced. - Instituted an Avionics Equipment Board to more
efficiently manage avionics hardware. - Improved SMC processes for Caution Warning
(including CW impacts of PRs), FCA/PCA, software
ICDs, Stage Test DVOs, and SPNs. Also notable
support for assessment of PCS development
programs. - EME expertise continues to be of top-notch
quality and has provided notable support of
testing, design reviews, IP integration, and
anomaly resolution teams.
B.2-1
12Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B.2 Technical Performance - Avionics and
Software Production (cont.) - Strengths (Continued)
- The Boeing GNC team did an outstanding job of
supporting the 8A GNC activation and checkout
TIM. This led to a well-planned and systematic
activation and checkout of the GNC system for 8A.
- The contractor has performed beyond expectations
in supporting testing, in such areas as 8A stage
testing, NASA/NASDA JEM CDH Joint Test 2,
planning for APM Joint Test 3A, supporting the
MEIT-3 CDH reassessment study, and test support
at KSC (e.g. S1 S-Band re-acceptance, video and
CDH support for S0 Combined Functional Test,
GNC support to Regression test, and overall EME
support). - Software teams have shown notable flexibility to
accommodate late requests for new PPLs and
patches, e.g. the Ku-band patch which was
accelerated from CCS R4 to R3. - The contractor has aggressively instituted fault
trees to resolve Avionics PRACAs. - The contractor provided notable facility support
in developing requirements for ISIL enhancements,
multiple test rig releases and upgrades, and
planning for software management on the new Sun
6800 in the MBF. - Superior initiative was shown by the DIT, e.g.
trying to reduce the number of Standard Out
products each cycle, helping the IPs integrate
CGS tools, and ensuring that the customer had the
best RCL possible for upcoming Timeliner testing.
- The contractor was highly effective in isolating
cable harness wiring problems of the Integrated
Truss Segment S0.
B.2-2
13Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B.2 Technical Performance - Avionics and
Software Production (cont.) - Strengths (Continued)
- The contractor has successfully supported
unplanned tasks without interrupting avionics and
software work, e.g. supporting the CARD and Node
3 relocation study. - Boeing has demonstrated exemplary performance in
the delivery, test and integration of software
products for quick turnaround (i.e. 24 hours) to
support MOD/MCC-H real-time operations and
testing. -
- Weaknesses
- The contractor continues to have problems meeting
ECZ and CCS software schedules. - Although the development cycle time for large
IFLs was reduced, the contractor continues to
commit to unrealistic schedules for Build
Specification Reports (BSRs) and IFLs resulting
in delivery dates not being met. Also, customers
continued to find BSR errors.
B.2-3
14Twelfth Period Midterm Evaluation Exhibit
A International Space Station Contract NAS
15-10000
- B.3 Technical Performance Cargo Integration
Hardware -
- Summary
- Overall, the contractor has shown improvement
for this period. The contractor has made some
progress in planning, coordinating, and
integrating across the various projects.
However, the contractors management needs to be
more proactive and involved on a daily basis.
This daily involvement is needed to help
facilitate timely communication, integration
across multiple projects, identification of
issues, and delivery of hardware per the agreed
to schedule. - Strengths
- Strong technical support was provided for
negotiating FRAM connector design with
ESA/Columbus. Quick turnaround on issue
resolution and actions. Contractor demonstrated
flexibility and desire to work with IP
limitations. - The contractor has made significant improvement
in schedule management and tracking for External
Carriers projects. Using these improved tools,
performance to plan has improved. - The contractors performance on recent ESP2 and
FSE design reviews has been outstanding. The most
significant example is the recent completion of
ESP2 IDR2. The presentations and data package
were well done and led to meaningful discussions
with the participants. All major issues were
identified and documented for follow-up. - The contractor has made progress in day to day
project management. Specifically, the contractor
has a much better set of project schedules in
place. - The contractor has improved in coordinating their
ground activities with the KSC Payload Ground
Operations Contractor (PGOC) for External
Carriers FSE support. An example of this is the
work the contractor did on the UF1 LMC FRAM
integration. -
B.3-1
15Twelfth Period Midterm Evaluation International
Space Station Contract NAS 15-10000
- B. 3 Technical Performance Cargo Integration
Hardware - Strengths (cont.)
- The contractor has made substantial progress in
their strategic planning. Specific examples
include the updated version of the External
Carriers Office Hardware Development Strategic
and Tactical Plans and development of a plan to
react to failures during assembly and a steady
state plan post-assembly. - Weaknesses
- The contractor continues to have significant
lapses indicating a reactive rather than
proactive management style. A specific example
is the recent attempt to deliver the PCU FSE, in
spite of the fact that required structural
analysis for carrier types identified in the FSE
specification were not complete. When questioned,
the contractor stated the subject requirements
were incorrect. While this assessment may be
true, identification of this issue AT DELIVERY is
unsatisfactory. This led to an avoidable delay in
acceptance (FCA/PCA) of this hardware. - The contractor continues to lack technical
communication and integration across different,
related External Carriers projects. An example
of this would be the FRAM and FRAM connector
projects. The contractor has been slow to
integrate these two projects, where connector
delivery and integration into the FRAM assemblies
is essential to assure FSE deliveries to ULF1 and
subsequent missions. Another example of this
would be the FRAM Connector (K) CDR. In this
instance, the connector design review meeting
started, without data packages being distributed
in advance to FRAM personnel ( others). - The contractor needs to improve on assuring
rigorous manufacturing standards for External
Carriers hardware. Examples of this include the
rework of the passive FRAMs and the UTAS, where
easily avoided manufacturing process faults
resulted in needless cost and schedule impacts. -
B.3-2
16Twelfth Period Midterm EvaluationInternational
Space StationContract NAS 15-10000
B. 3 Technical Performance Cargo Integration
Hardware
- Weakness (continued)
- The contractor needs to improve on the timeliness
associated with identifying long lead items, and
then following through on the procurement.
Examples of this include the procurements
associated with the FHRC and UTA FSE. - The contractors management needs to be more
pro-active and involved on a daily basis. It is
unclear if the management is involved in the
daily implementation, across the various
projects. This daily involvement is needed to
help facilitate communication, integration across
multiple projects, and delivery of hardware per
the agreed to schedule. In addition, this daily
involvement will allow the contractor to better
understand the customers concerns/issues.
B.3-3
17Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B.4 Technical Performance Launch Package
Integration - Summary
- The contractor has improved performance
during this period and demonstrated superior
initiative and provided quality support to the
Launch Package and Manifesting teams. - Strengths
- The Boeing Mission Managers and their supporting
organizations have improved their inputs of the
hardware handling and processing requirements
to the Launch Package Teams, Stowage and Packing
organizations. - Boeing demonstrated superior initiative in
developing an ISS Manifest Analysis Tool (IMAT).
The IMAT has resulted in significant process
improvements and has greatly improved ISS ability
to respond quickly and accurately to changing
requirements. - The contractor has provided notable support in
assuring that Boeing hardware and products are
delivered per schedule to support UF-2. - Boeing has instituted a weekly telecon to status
the Boeing hardware manifested for a specific
flight. These meetings are used to help identify
and resolve any hardware processing/delivery
issues and have helped to reduce the number of
surprises regarding late hardware deliveries.
They have become instrumental in helping to
involve the appropriate parties, including
management, necessary to make critical decisions
and establish recovery plans for late deliveries.
- Weaknesses
- Although improving, identification of shortages
and/or late deliveries continue to be identified
too late in the process (ie shortly before the
required hardware on-dock date).
B.4-1
18Twelfth Period Midterm Evaluation International
Space Station Contract NAS 15-10000
-
- B.5 Technical Performance Preparation for
Flight - Summary
- The Boeing VIPeR team has performed exceptionally
well this period, providing analysis supporting
ISS Assembly Flights and ISS on-orbit
operations. Boeing continues to provide notable
support in the conduct of CoFR reviews and Stage
Integration Reviews and in providing the products
that support these reviews. The Boeing EBIT Team
has shown weakness in overall management with the
absence of detailed schedules and late delivery
of flight critical analysis. - Strengths
- The VIPER team continues to perform in an
outstanding manner. Specific examples include - The integration and development of the ISS
external stowage configuration report through
flight 4R. - Continued improvement of tool development for
on-orbit data correlation to improve quality of
data inputs and outputs and improved means of
delivering quality products to customers. These
include initial development and peer review of
the SETI power/thermal mission support tool for
targeted use during the 8A mission, development
of an automatic on-orbit data download
capability, and process improvements in the
delivery of the Semi-Annual Performance
Assessment Report (SAPAR). - Exceptional and timely response in developing a
SSODB repository for flight attitudes for the ISS
Program. - Leading an effort to develop a process for
including the international partners
capabilities into the SSODB. - Supporting NASAs assessments to maintain 3
versus 6 crew.
B.5-1
19Twelfth Period Midterm Evaluation International
Space Station Contract NAS 15-10000
-
- B.5 Technical Performance Preparation for
Flight - Strengths
- Boeing has performed exceptionally well in
maintaining and closing issues associated with
Stage Integration Review 7 (SIR 7, ULF-1, 12A,
12A.1) and in preparing for SIR 8 (13A, 13A.1,
and 15A). - Boeing has done an outstanding job preparing for
and conducting the Launch Package Assessments
(LPA) and the CoFR Stage Operations Readiness
Review (SORR). - The contractor Incorporated stage verification
compliance milestones into the OPMT to insure
time visibility and action for the verification
products that support CoFR. - The Boeing KSC Imagery Group has established new
procedures for providing imagery status of the
different flights. The report is updated monthly
and contain easy to understand graphics depicting
acquired imagery vs. total number of images to be
acquired, schedule, and budget data. Boeings
outstanding management tools applies for tracking
imagery have resulted in timely delivery of Pre
Flight Imagery Plans and actual images. - Boeing performance has greatly improved in the
on-orbit installation drawing task. They have
recently implemented the Operations Sequence
Report, which ensures better coordination with
MOD and less rework for both teams in support of
SORR. - Weaknesses
- Boeing has not provided a detailed schedule from
which to manage the EBIT process. There is a
lack of efficiency in the management of the
process and products which result in the late
delivery of flight critical analysis.
B.5-2
20Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B.6 Technical Performance Assemble, Sustain and
Operate On-Orbit Vehicle - Summary
- The contractor continues to provide
exceptional technical leadership and support to
the on-orbit vehicle, resolving issues in a
timely manner and ensuring the proper resources
and skills are available when required in the
majority of cases. - Strengths
- The contractor continues to provide superior
technical leadership and support to on-orbit ISS
operations. Some examples of exceptional
support include - Extensive fault tree and root cause investigation
for the BGA anomaly, identifying potential flight
attitude solutions and identifying a potential
fix (thermal blanket) and manufacturing/flying it
within one month. - ISS environments and contamination team showed
outstanding progress on development of
understanding of the ISS plasma charging hazard
resulting from PV array driven charging for
vehicle configurations prior to flight 12A. - Boeing's CDH MER support has been very
responsive to the flight control team. They have
supported the CDH flight controllers positively
with timely results. On multiple occasions, the
CDH flight controllers have been able to quickly
correct problems while preserving the appropriate
data because of the quick turnaround of requests
to the MER CDH personnel. - The SM Loads and Dynamics team has provided
timely mission support with prompt VAC analyses,
IP support, and very critical analysis/assessment
of loading events associated with hardware
malfunction off-nominal performance of ISS
hardware.
B.6 -1
21Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B.6 Technical Performance Assemble, Sustain
and Operate On-Orbit Vehicle (cont.) - Strengths
- The majority of the contractors MER systems
consoles continue to maintain strong
relationships with the Flight Control Team
counterparts, resulting in the ability to address
significant on-orbit issues in a timely manner. - Boeing management has provided valuable
suggestions to training content restructuring
that has helped reduce future cost of training.
In addition, they are working to ensure a smooth
transition between JSC and Marshall for payload
training responsibilities. - Weaknesses
- None Identified
B.6-2
22Twelfth Period Midterm EvaluationInternational
Space StationContract NAS 15-10000
- B. 7 Utilization
- Summary
- The contractor continues to provide
exceptional hardware and software technical
expertise in supporting the integration of
payloads with the ISS. During this period of
performance, Utilization has met all requirements
in support of integration of payloads into
Destiny. Management of PaRIS interfaces with the
Habitat Holding Racks (HHRs) has been inadequate,
resulting in cost and schedule impacts. - Strengths
- The contractor has continued to excel in the area
of payload flight SW deliveries and related
documentation. All products were delivered on
schedule and within budget even though numerous
payload manifest changes continue to occur as
well as late payload developer submittals. - Extensive support was provided for the MELFI
verification review prior to MELFI being shipped
to KSC from Europe. This support helps abate the
risk of late verification issues arising at KSC
which could impact the ULF-1 launch readiness. - Completed and delivered all Payload Rack Checkout
Units (PRCU) and Suitcase Test Environment for
Payloads (STEP) units. Timely delivery and
acceptance of PRCU unit 6 allowed the MSG project
to conduct sub-rack verification for the UF-2
mission. Completed and delivered all Payload Rack
Checkout Units (PRCU) and Suitcase Test
Environment for Payloads (STEP) units. Timely
delivery and acceptance of PRCU unit 6 allowed
the MSG project to conduct subrack verification
for the UF-2 mission. The contractors
proactiveness and ingenuity in the delivery
process prevented delays in the delivery of these
units. In addition, the Boeing team has also
provided a well thought out and thorough forward
plan for transitioning into sustaining tasks. - In a mere 3 1/2 working months, the contractor
designed, developed, fabricated, tested, and
delivered the Passive Common Attach System
Simulator (PCASS) (SSCN 5811). Not only was the
PCASS delivered ahead of schedule, but it far
exceeded its performance requirements. This
early delivery allowed the completion of critical
path testing of the MBS ahead of schedule,
earning recognition from senior ISS management.
B.7 -1
23Twelfth Period Midterm EvaluationInternational
Space StationContract NAS 15-10000
- B. 7 Utilization
- Strengths (continued)
- Completed the S3, MCAS, and keel revised envelope
analyses, completing the process for S3 sites.
Results are captured in PIRNs scheduled for final
End to End Berthing Integration Team (EBIT)
approval on March 6 and the Payload Control
Boards formal CR to update the document. The
contractor was able to perform this task which
required multi ISS and SSP discipline integration
when it was not carried as a high priority by
those teams. - The administrative services being provided for
the PSCP have been exemplary. Meeting minutes
have been generated on average in two days time.
In addition, the minutes have been accurate,
requiring very minimal if any modifications.
This quick turnaround of minutes allows PSCP
decisions and direction to get out to the payload
SW community quickly allowing them to respond and
implement in a timely fashion. - The contractor has processed a significant amount
of PIRNs which resulted in a better defined
interface for ISPRs. In addition, a new
structured process has been set up to handle PIRN
traffic related to core systems interface
documentation. - Weaknesses
- Inadequate coordination with Boeing HHR Project
on the PaRIS ICD resulted in a HHR schedule delay
and cost impact.
B.7-2
24Twelfth Period Final Evaluation
International Space Station
Contract NAS 15-10000
- B. 8 Logistics Maintenance
-
- Summary
- The contractor has performed exceptionally well
during this period in all areas of logistics
support. Of note is their development of
on-orbit maintenance planning, the support to the
S5 flight article move, a new management plan on
new spares procurements, the tracking and
management of the depot certifications, and the
support to logistics data systems. In addition,
the contractor has shown marked improvement in
the delivery of logistics data products. The
contractor needs to continue to work on ensuring
that data required by other organizations to
support development of logistics products, are
provided in a timely manner so that product
deliverables arent impacted. - Strengths
- The contractor has done an exceptional job
developing on-orbit maintenance plans. Examples
include - Performing a superior integrated analysis
validating the delivery plans for Nitrogen and
Ammonia tanks during assembly, and providing new
insight into post assembly plans. - Developing a comprehensive plan for addressing
potential failures of cable boxes on-orbit that
allowed the Program to avoid potential costs of
additional spares procurement and FSE development
beyond the baseline. - Developing and coordinating an EVA scenario for
removal and replacement of a Utility Transfer
Assembly within a single EVA sortie. By providing
this quality product at the right time, the
Program will be able to defer FY02 and 03 cost of
FSE. - The contractor has provided outstanding support
in the development and implementation of a
Common Spares Pool approach with the
International Partners.
B.8-1
25Twelfth Period Final EvaluationInternational
Space Station Contract NAS 15-10000
- B. 8 Logistics Maintenance (cont.)
-
- Strengths (continued)
- The contractor has implemented several corrective
actions to improve forecasting and management of
the spares schedules. These include - Implementing a monthly Super CAM meeting to
review the cost, schedule and performance for
spares hardware. - Streamlining the weekly spares VTC to more
clearly focus on specific cost and schedule
milestones. - Initiating a review team to closely monitor PIO
proposal implementation process from inception to
definitization. This has successfully reduced
the total cycle time to implement new
procurements. - The contractor support of logistics data systems
has been exceptional. During this period the
contractor completed the KSC PGOC transition from
KIMS to GOLD on December 01, 2001 as planned. To
meet this date, the contractor overcame
significant technical challenges to accomplish
this task on time including resolving issues with
the KSC to JSC server interfaces. In addition,
the contractor identified several problems with
the Enhanced Automated Graphical Logistics
Environment (EAGLE) Software and quickly worked
with the vendor to develop user friendly
solutions. - The contractor delivery of logistics data
products has been greatly improved. Examples of
this include - Exceeding the minimum provisioning data
requirement by five ORUs in support of the
Provisioning Technical Documentation Meeting. - Converting the Lockheed-Martin Mil-Std-1388 2A
data to Mil-Std-1388 2B data and training
engineering personnel on how to use the EAGLE 2B
Software System. - Converting CSA Logistics Support Analysis 2A data
to 2B data .
B.8-2
26Twelfth Period Final EvaluationInternational
Space Station Contract NAS 15-10000
- B. 8 Logistics Maintenance (cont.)
-
- Weaknesses
- The contractor has not provided detailed
schedules of their development plans for the
end-to-end external maintenance scenarios. This
lack of detailed schedules has impacted the
ability of institutional organizations, such as
MOD, Crew Office and Engineering, to support this
effort. - The electronic delivery of the OP04 (maintenance
procedure) and OP05 (illustrated parts breakdown)
needs improvement. The contractor was late in
providing an essential cross reference table
which caused the LSAR Review of the data to slip
one (1) week. - The contractor did not adequately monitor the
schedule and cost performance of the Lockheed
Martin Sunnyvale spares.
B.8-3
27Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B. 9 Technical Performance - Configuration
Management and Data Management/Integration - Summary
- Boeing Configuration Management and Data
Management/Integration has demonstrated overall
highly effective performance during this
evaluation period. Boeing continues to provide
outstanding support on the on-orbit mission
configuration status accounting activities. The
performance of the SW CM team in configuring the
IFLs, patches and PPLs has been outstanding.
Improvement is needed in coordination and
planning with engineering, quality and CM to
enable the closure of open paper in time to
support the COFR reviews. - Strengths
- Boeing KSC continues to provide outstanding
support of the on orbit configuration
reconciliation efforts with on orbit stage
reconciliation 99.5 complete. - Boeing has made notable progress in implementing
change process improvement initiatives
(streamlined SSCMs, CR reduction) and has
aggressively worked the NASA initiated Open CR
Performance Improvement Plan. - Boeing Software CM has improved the quality of SW
status accounting by consolidating site data into
PVCS. - Boeing Data Management continues to provide
outstanding support to the Program Data
Management and Integration Team (PDIT) in the
development and implementation of a streamlined
process for receiving and tracking Boeing data
deliverables. - The Boeing VDI team did a notable job resolving
issues and meeting the October and January
milestone VMDB data deliveries. Outstanding
support in defining Application Support Data Base
(ASDB) requirements and helping define VMDB
Requirements Database (VRD) data for conversion
was also provided.
B.9-1
28Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B. 9 Technical Performance - Configuration
Management and Data Management/Integration - Weaknesses
- Boeing was delinquent in providing completed
build paper and engineering rationale for
subsequent as-designed vs. as-built discrepancies
on the S0 truss in time for the 8A SORR. This
resulted in a CoFR exception which required
extraordinary effort by engineering and CM to
complete last minute waivers prior to the FRR.
Late waivers were also processed on the 7A.1 and
UF-1 missions.
B.9-2
29Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B. 10 Technical Performance International and
GFE Integration - Summary
- The contractor has provided outstanding
support to the MSFC Node Projects Office, ESA SW
and Systems Engineering Integration. The
contractor has provided notable support and
coordination regarding FGB stowage
enclosures,RSC-E integration activities for UF-2,
Increment 5, and for the 7P and 4S Stage
Operations Readiness Reviews. The contractor has
not performed well in the areas of Columbus
Avionics and Software schedule maintenance,
action item and issue resolution. - Strengths
- Boeing provided outstanding support to the the
Node 2/3 Projects for the following Node
activities - Working with NASA and Alenia to coordinate the
planning, installation, and testing of CBM
concurrently with Alenia activities. - Supporting the Node 3 PIDS baselining effort.
- Providing lessons learned from other elements and
an independent assessment of the Node 2 human
factors and logistics verification program during
the Node 2 Verification TIM. - The Contractors effort in defining SW
interfaces, as well as systems engineering
technical support associated with ESA/Columbus
integration continues to be a strength. The
contractor assumed responsibility for the
development and maintenance of the ESA/Columbus
SW ICD. - Boeing provided notable support and coordination
in regards to the FGB stowage enclosures. Boeing
has kept the task on schedule and provided status
on a regular basis. Boeing support and effort
helped to integrate the MPLM stowage of the
enclosures for Flight UF-2. Additionally, Boeing
coordinated the enclosure installation crew
training in Moscow.
B.10-1
30Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B. 10 Technical Performance International and
GFE Integration - Strengths (cont.)
- Boeing continues to effectively coordinate with
RSC-E, the Service Module Debris Panel (SMDP) and
TDK (Transportation Device for Debris Panels)
integration activities for Flight UF-2. Boeing
has provided the technical data (interface and
thermal loads data) needed by NASA and RSC-E for
integration analysis and certification of this
payload. Boeing coordinated design of the
stowage adapter for the temporary stowage of the
SMDP on Pressurized Mating Adapter-1.
Additionally, Boeing provided notable support in
organizing UF-2 and Increment 5 crew training in
Moscow. - Boeing support was instrumental to the successful
7P and 4S Stage Operations Readiness Reviews. - Weaknesses
- IP Integration support with regard to schedule
maintenance, tracking and closure of action
items, and meeting minutes continues to be weak. - IP integration support to negotiations of issue
resolution for the ESA Columbus hardware
interfaces and test 3A has been ineffective. - The contractor was delinquent in providing
interface information on the TVCIC/PTU interface
to allow the Floating Potential Measurement Unit
(FPMU) to be integrated in place of the PTU. This
information was requested in November however
the complete, technically correct information was
not provided until April 3rd. By this time, the
design was so far along that design changes of
the qual FPMU hardware were required, resulting
in cost and schedule impacts.
B.10-2
31Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B11. Technical Performance Safety and Mission
Assurance - Summary
- The contractor actively participated in ISS
flight operations, stage operations, and
pre-flight and post-flight activities and was
proactively engaged in the resolution of
technical issues and in-flight anomalies
throughout the reporting period. The submittal of
FMEA/CIL worksheets has occurred in a timely
manner. However, Critical Item presentations are
not provided to ISS management on schedule,
resulting in late identification of risk to
management. - Strengths
- The contractor proactively supported the 8A SSRMS
brakes-on berthing loads issue. The contractor
accurately characterized the risks and provided
options to minimize the risk. - The contractor successfully backfilled
nonconformance reports from major Boeing sites
into the PRACA system, ahead of the agreed-to
schedule. - Software Safety captured hazard analysis results
for Computer Based Control Systems into a
database structure. The delivery of the hazard
data in this format enables JSC to use computer
based tools to produce hazard traceability and
command restrictions for use in Operations
products. This product is a significant value to
the safety review process.
B.11 -1
32Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- B11. Technical Performance Safety and Mission
Assurance - Weaknesses
- During this period, twelve (12) mishaps were
recorded where ISS personnel were injured on duty
or ISS hardware was damaged. Although
Boeing-ISS/GO management is placing emphasis on
safe work practices and safety awareness,
continued improvement in safety awareness is
needed. - The contractor is not actively managing resources
at the HB and Huntsville sites. This is
evidenced by cost overruns in quality assurance
that are not being dealt with in a timely manner.
- The contractor did not adequately coordinate and
integrate SMA issues prior to, and during,
several ISS flight reviews (7P and 8A SORR, 8A
delta SORR). - The contractor continued to experience problems
in providing necessary audit material and action
item closure for PCAs. - During the S1/P1 PCA, the contractor was unable
to provide build paper and draft ADPs for
review/audit, making it difficult to accomplish
the objective of the PCA and led to large numbers
of actions. The audit also revealed a general
lack of quality discipline in the manufacturing
and test documentation. - The contractor is slow in closing action items
assigned at the PCA/AR and the closure dates are
routinely pushed to the right against the launch.
- First time quality of Reliability Block Diagram
models is not at the desired level, which
requires additional reviews and increased
man-hours to ensure the model is accurate and
complete. - The contractor failed to review the
implementation of design changes or operational
controls to eliminate the hazards associated with
the TCS braid flex hose sharp issue. The
Contractor also failed to initiate a SCAN report
to notify other US Hardware Providers and
International Partners of the issue. Only after
NASA Management involvement was a SCAN initiated.
B.11-2
33Twelfth Period Award Fee Evaluation International
Space Station Contract NAS 15-10000
- Small and Disadvantaged Business (SDB) (15)
- Summary
- The contractor continues to exceed the NASA
SDB goal of 8. The contractors current overall
contract SDB percentage is 8.2. - Strengths
- Boeing set in place their infrastructure for the
addition of the HUB/Veterans/HBCU-MI goals by
performing an information systems upgrade that
captures input of these new supplier diversity
goals. - Boeings supplier, Muniz Engineering, certified
as a Service Disabled Veteran business. This
contract is valued at approximately 2.98M, which
equates to about 1.5. - Boeing's Protege', Cimarron, completed and
received ISO certification. - Boeing set in place an HBCU/MI initiative by
implementing the 3rd year teacher in residence at
Prairie View AM University. - Weaknesses
- None
C.1 -1
34Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- COST POOL
- Cost Performance
- This factor measures contractor cost performance
in support of executing the program baseline
plan. - Summary
- The variance to the contract level funding
baseline, as evaluated through the March 2002
financial reports, was a 6.4 under-spend, which
when adjusted for performance, showed a potential
range of actual performance from the 6.4
under-run to a 3.6 overrun. There are
indications of a potential budget impact to
future years due to performance within the period
(estimates up to 10.3M). The figures are
estimates which indicate nominal performance.
See the cost assessment summary attachment.
Cost -1
35Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
Cost Performance SEE EXCEL SHEET
Cost-2
36Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- Cost Management
- This factor measures contractors effectiveness
in implementing the FY 2002 program baseline. - Summary
- The contractor expended significant effort on
the development of new financial reporting
systems (OPP/Cobra) and the implementation of the
new NASA Form 533. There continues to be
significant problems in the cost management area.
Financial reports were late and contained
excessive errors, the earned value management
system has degraded and the risk and opportunity
system is not adequately portraying risks. - Strengths
- The customer reporting team was very responsive
in providing detailed variance information and
supporting data, and resolving discrepancies in
the reports. A particular example was the
ability to quickly provide extensive historical
data to the independent cost estimating teams
supporting the program. - Boeing implemented a NASA Form 533 M/Q during the
period. The transition to this comprehensive
financial report allowed for the discontinuation
of five existing reports. The new document
provides detailed total cost, a six-month
forecast, fiscal year forecast, and latest
revised estimate down to the 4th level Work
Breakdown Structure (WBS). In addition, the
program now has visibility down to the 4th level
on total cost and EPs and at the 2nd level WBS
by cost element. Additional visibility is
provided for spares and subcontractors. -
Cost-3
37Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- Weaknesses
- Continued significant issues with financial
reporting - Reconciliation issues between the financial
reports and management presentations remained a
significant concern. Financial reports did not
reconcile with management presentations or the
SuperCAM database until March. - Boeing financial reports continue to contain
excessive errors and unexplained problems.
Boeings deficiencies in the Forecast Report/533
and the primary earned value report reduced the
governments confidence in the Boeing financial
systems and processes. - Deliveries continue to be late. The forecast
report/533 (PC27) was delivered late 3 out of 5
occurrences. It was 4 days late in December, 5
days late in January and 11 days late in
February. - A complete SuperCAM database, which includes
detailed earned value data, has not been
available since December. -
Cost - 4
38Twelfth Period Final Evaluation International
Space Station Contract NAS 15-10000
- Weaknesses (cont.)
- The Earned Value Management System (EVMS) has
degraded examples include - The contractor reported a 95M increase to the
Variance at Completion for the DDTE work due to
past period reconciliation. This action
indicates a significant failure in the primary
early warning tool for the contract. NASA has
not received adequate explanations of this
performance. - The Defense Contract Audit Agency found
discrepancies in data between the EVMS and
accounting systems for 1999. - The inability to properly measure performance on
new work (OPD), for example the External
Carriers, indicates this tool is unreliable. - Risk Opportunities Management System
- Boeing failed to meet NASAs requirement to phase
data by fiscal year. - The system failed to consistently capture rate
issues. -
Cost - 5
