Todd Farley - PowerPoint PPT Presentation

About This Presentation
Title:

Todd Farley

Description:

and the Multi-Center Traffic Management Advisor (McTMA) Todd Farley todd.c.farley_at_nasa.gov (650) 604-0596 Agenda McTMA training, part 1 Time-based metering Why the ... – PowerPoint PPT presentation

Number of Views:109
Avg rating:3.0/5.0
Slides: 61
Provided by: ToddF73
Category:

less

Transcript and Presenter's Notes

Title: Todd Farley


1

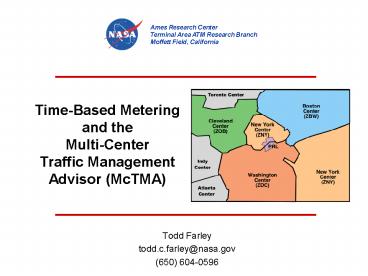

Time-Based Metering and the Multi-Center
Traffic Management Advisor (McTMA)
  • Todd Farley
  • todd.c.farley_at_nasa.gov
  • (650) 604-0596

2
Agenda
  • McTMA training, part 1
  • Time-based metering
  • Why the push for metering? Why here? Why now?
  • Autopsy of failed metering programs
  • Metering then and now
  • The transition to time-based metering
  • It can be done. Heres how its going at ZLA
  • Introduction to McTMA
  • McTMA system architecture
  • Whats next?
  • The game plan and your role in it

3
Time-Based Metering
  • The M word

4
Time-based metering
We tried that already. It didnt work. You
can leave now. - Boston Center controller
This is the best feed of aircraft I have seen
from ZLA ever. - SoCal Tracon controller
5
Time-based metering
  • Why the push to go to metering?
  • Theoretically proven to be more efficient
  • Throughput
  • Arrival delay
  • Airborne holding
  • but what about workload?

6
TMA Single-Center vs. Multi-Center
  • In practice so far, so good
  • At every TMA site so far, results from
    operational use have validated the benefits that
    theory suggests
  • including workload

7
Time-based metering
  • Why the push to go to metering here?
  • Weve tried the obvious places and its worked
  • ZFW, ZMP, ZLA, etc.
  • ZLA is the first facility to transition from
    miles-in-trail to time-based metering, and the
    results have been positive(more on that later)
  • This is the Northeast Corridor theres more
    demand and tighter constraints here than
    anywhere
  • The Northeast is the ultimate test
  • Why Philly?
  • RTCA recommendation
  • Its location makes it interesting from a research
    perspective

8
Time-based metering
  • timebased metering (tim based met r-ing) n.
    1. A traffic management alternative to
    miles-in-trail spacing to de-peak the arrival
    demand to meet a downstream restriction. 2. A
    sector control technique by which aircraft are
    vectored (speed, heading, and/or altitude) to
    meet a crossing-time restriction at a
    coordination fix.

e
9
Time-based metering
  • In theory, a more efficient way of spacing
    traffic flows to spread out the demand to meet
    capacity.

10
Time-based metering
  • In practice, works very well in airspace with
    large, open sectors that have been metering for
    years.
  • for example, ZFW ZMP

of course, thats not the case here.
11
Arrival airspace comparison
  • ZNY characteristics
  • Small, complex sectors
  • Heavy crossing traffic
  • Flights in transition

12
Time-based metering
  • Heres the basic questionIs there a way to
    implement time-based meteringin complex airspace
    that makes sense in terms of efficiency and
    workload?

13
McTMA cadre
Traffic management Jay Conroy, Jack White NATCA
CPC Mike Dowd
Traffic management Mark Evans, Doug
Davis NATCA CPCs Jim Bartel, Bob Weaver
Traffic management Boucher, Kurz,
Rosenberg NATCA CPCs Golder, Kohler, Cummings
Traffic management John Kelley NATCA CPC
Patrick Rodden
NASA Tom Davis, Todd Farley, Ty Hoang, Steve
Landry, Kathy LeeMITRE Kerry Levin, Dennis Rowe
Traffic managementMike Klinker, Barry
Constant NATCA CPC Bob Padgett
14
We tried that already. It didnt
work.Metering Then and Now
  • This is not your fathers metering system

15
Time-based metering predecessors
  • En-Route Metering (ERM)
  • 1970s-80s R.I.P.
  • Arrival Spacing Program (ASP)
  • 1980s-today
  • Both failed to work in complex airspace

16
Time-based metering predecessors
  • Shortcomings are well understood, and
    surmountable
  • ERM and ASP are Host-resident programs
  • Subject to processing limitations of the Host
  • Inaccurate trajectory estimates
  • No wind data
  • Inaccurate trajectory estimates
  • Host-resident programs unable to interface with
    other Centers
  • Unable to develop a common metering plan across
    Centers
  • Adjacent Centers worked with uncoordinated
    arrival metering plans

17
Time-based metering with McTMA
  • McTMA is a completely different approach
  • Not a Host-resident programMcTMA is a brand
    new, independent infrastructure of
    state-of-the-art computer equipment
  • Superior computational resources make possible
    the use of far more sophisticated trajectory
    modeling and scheduling algorithms
  • More accurate trajectory estimates

18
Time-based metering with McTMA
  • McTMA is a completely different approach
  • McTMA has access to hourly wind updates (RUC
    forecasts)
  • More accurate trajectory estimates
  • The inherent advantages of the TMA approach over
    that of ERM or ASP have resulted in significant
    operational improvements at every facility that
    has upgraded from ASP to TMA
  • Land more aircraft per hour
  • 5-8 throughput increase
  • Less metering

19
Time-based metering with McTMA
  • McTMA is a completely different approach
  • McTMA is fully integrated between Centers
  • Access to all relevant flightplan and track data
  • Able to exchange metering data across Centers
  • Adjacent Centers synchronized to a common arrival
    metering plan

20
The transition to time-based metering
  • It can be done. Heres how its going at ZLA

21
LAX transition to metering
  • Traffic management before metering
  • Adjacent Center MIT initiatives or GDP or both
  • MIT-based initiatives (jets)
  • Call for release on satellite departures (ZLA and
    SCT TMU)
  • Internal holding at SLI, DARTS, LAHAB
  • No-notice holding by ZLA at SCT boundary
  • Occasional unfilled gaps on finals
  • Arrival numbers often below advertised AAR
  • TMS delays common on IFR days

22
LAX transition to metering
  • Benefits for LAX arrival operations
  • ZLA
  • Vectoring occurs in High Altitude sectors
  • Less coordination necessary (speeds/vectors)
    between SCT feeder sectors and ZLA sectors
  • No-notice holding greatly reduced
  • SCT
  • Arrival flow to SCT based on all traffic and the
    runway availability
  • Aircraft are staggered on merging routes (East
    gate)
  • Speeds faster transitioning to finals
  • Less space wasted on finals

23
LAX transition to metering
  • Traffic management initiatives for initial
    time-based metering trials
  • Implemented to allow for safe transition to new
    procedures associated with time-based metering
  • May 14 - TMIs (regardless of AAR at LAX)
  • 30 MIT from East Adjacent ARTCCs - ZAB, ZDV, ZLC
  • 20 MIT from ZOA
  • SAN arrivals (from the East) routed south O/IPL
    (Sector 39)
  • 10 MIT - VTU Departures (from SCT)
  • Altitude capping for arrivals to LA Basin/San
    Diego area airports (i.e. BUR/VNY, SNA/LGB,
    SAN/CRQ)
  • June 4 - TMIs back to normal operations.
  • Dynamic application based on sector demand and
    workload

24
May 30 metering trial results
  • May 30 (1700-1850Z)
  • WX VIS 3 MI, BKN 006, OVC 008. VIS North 2 MI
  • No VAPs
  • LAX advertised AAR 64 due to heavy mix and 3 mile
    separation at THD
  • East Winds at altitude
  • Actual arrivals 1710-1810z 69
  • Heavy/757 mix 38

38 Heavy/757
38 Heavy/757
25
June 7 metering trial results
  • June 7 (1615-1900Z)
  • WX IFR OVC 008
  • No VAPs
  • LAX advertised AAR 68
  • Actual arrivals 1740-1840z 69
    (Heavy/757 mix 43)
  • Actual arrivals 1800-1900z 71
    (Heavy/757 mix 34)

43 Heavy/757
34 Heavy/757
26
June 10 no metering
  • June 10 (1700-1900)
  • WX BKN/OVC 020 (IFR)
  • No VAPs
  • LAX advertised AAR 68
  • Actual arrivals 1700-1800z 59
    (Heavy/757 mix 32)
  • Actual arrivals 1800-1900z 61
    (Heavy/757 mix 36)
  • 3 A/C held _at_ VTU/DARTS for 10
  • SAN 27 (Ground Delay)

27
Transition to metering at LAX
  • SCT statement regarding June 10
  • It is difficult to compare metering vs.
    non-metering arrival numbers however, I believe
    that if metering had been used (on June 10), the
    arrival numbers would have been higher, without
    the delays incurred today.
  • Gary Hobbs, STMC, Southern California TRACON

28
June 21 metering trial results
  • June 21 (1630-1830Z)
  • WX IFR OVC 020
  • No VAPs
  • LAX advertised AAR 64 - 68
  • Actual arrivals - 10 minute running totals
    1630-1830z
  • 67-66-68-67-68-68
  • Heavy/757 Mix - 10 minute
  • running totals 1630-1830z
  • 31-34-35-39-38-41
  • Metering has provided a more consistent flow of
    traffic over long periods of time

41 Heavy/757
38 Heavy/757
35 Heavy/757
29
June 27 metering trial results
  • June 27 (1630-1850Z)
  • WX IFR OVC 020
  • No VAPs until 1815z
  • AAR 72 _at_ 1815z
  • LAX advertised AAR 68 - 72
  • Actual arrivals - 10 minute running totals
    1730-1900z
  • 66-68-69-69
  • Heavy/757 mix correlates to net hourly arrivals

30
Traffic flow from the East is staggered reducing
the incidence of vectoring within TRACON airspace.
31
Internal traffic fits into overall scheduling
plan as a result of TBM.
32
ZLA transition to metering
  • SCT testimonials for time-based metering
  • This is the best feed of aircraft I have seen
    from ZLA (to LAX) ever.
  • Doug Voelpel, SCT LA Area
  • We were busy (during rush on June 7), but we
    were never out of control and we consistently
    had enough aircraft to fill both of the finals.
  • Dan Boyle, SCT LA Area
  • Do you have to stop metering?
  • SCT TM (daily)

33
The bottom line
  • Improved awareness results in
  • Fewer surprises
  • Earlier knowledge of traffic and delay spikes
  • Improved quality of information to controller
  • More consistent flows reduce
  • No-notice holding
  • Incidence of excessive ground delays
  • Frequency of sudden need to create a hole in
    sequence, e.g., for aircraft in a low sector
  • Fluctuation in flow rates into approach airspace
  • Coordination with TRACON, TMCs, supervisors
  • Allows flexible traffic options
  • Spacing is based on runway availability
  • Delays can be effectively managed according to
    sector workload
  • Enhanced credibility with airspace users
  • Improved accuracy of delays and holding
    predictions
  • Equitable distribution of delays counters
    perception of favoritism

34
Introduction to Multi-Center TMA
  • Officially TMA-MC
  • NASA Jive McTMA

35
What is TMA?
  • Traffic Management Advisor
  • TMU planning tool for arrival rush operations
  • Tool for passive communication/coordination
    between ARTCC(s) and TRACON
  • Time-based metering tool
  • Purpose Help generate and implement a more
    efficient arrival plan for the adapted TRACON
    airport
  • Seeks to manage these arrival flows while the
    aircraft are still in Center airspace
  • Goal improve throughput, ease workload, reduce
    delay, increase capacity, improve coordination
    between facilities
  • TMA is being deployed nationally as part of the
    FAAs Free Flight Program.

36
What is TMA in practical terms
  • Predicts arrival demand
  • TMA provides fresh (12-second update), accurate
    prediction of the arrival demand
  • Matches demand to capacity
  • Based on constraints entered by the TMC (e.g.,
    AAR, meter fix closures, etc.), TMA computes a
    time-based schedule by which arrival demand will
    meet (and not exceed) the capacity of the airport
    TRACON
  • Provides metering targets
  • Sector controllers implement the schedule by
    vectoring aircraft to meet crossing times posted
    on their radar displays

37
What is TMA-MC?
  • TMA Multi-Center is an extension of the TMA
    Single-Center to regions where more than one
    facility is significantly involved in arrival
    traffic flow management
  • TMA-MC creates a network of TMAs at adjacent
    Centers
  • Enables transition to time-based metering in
    complex airspace
  • Provides scheduling information at adapted
    runways, approach fixes, and upstream Center
    boundaries
  • Facilitates regional collaboration
  • TMA-MC is a priority research project for the
    FAAs Free Flight Program, with a goal of
    providing capability in the field in the
    2004-2005 timeframe.

38
TMA basic system description
Atmospheric data
TMC Flow Visualization
Controller advisories
System control communication
Arrival time prediction
Flight plan data Radar Track Speed Controller
commands
Constraint Scheduling
Operational ATC Computer
TMA Workstations
39
TMA functions
  • TMA (single-center, multi-center, whatever)
    essentially does three things
  • Predict arrival demand more accurately
  • than anything available today
  • Help TMU develop a better plan for the arrival
    rush
  • via Timeline display (see next slide) and a
    much, much smarter scheduling algorithm than has
    ever been available with ASP
  • Produce metering lists to implement the overall
    arrival plan.
  • The advisories are designed to distribute the
    metering delay (i.e., workload) upstream and/or
    downstream across different sectors, areas, and
    even facilities. The result is that separate
    flows into a common destination (PHL TRACON, for
    example) are synchronized to the overall master
    arrival plan generated in the TMUs.

40
TMU timeline display
41
DSR sector controller meter list
42
Field test phases
  • Round 1 Multi-Facility Collaboration (March -
    June)
  • TMA to provide TMCs in multiple facilities with
    consistent, accurate arrival information
  • Each TMU to use TMA to help develop a coordinated
    arrival plan
  • Develop the ops concept
  • Determine hierarchy for decision-making between
    facilities
  • Round 2 Metering (Fall 03 - Spring 04)
  • Use TMA time-based scheduling
  • Enable free-flow of heavily saturated sectors
    while metering others
  • Transition to time-based metering in all McTMA
    facilities
  • Develop operational procedures for metering in
    multiple facilities
  • Determine costs/benefits of metering in complex
    airspace

43
Challenges for McTMA in NE Corridor
  • Complex airspace
  • Involves multiple facilities (TMUs, sectors, and
    TRACONs)
  • Small sectors, restricted controllability
  • Tower enroute control (TEC) traffic
  • Crossing traffic flows
  • Streams of metered traffic with unmetered traffic
  • Transition to metering control techniques
  • Potential benefits
  • Accurate prediction a reliable window on the
    next 90 minutes
  • Smoother traffic flow fewer ties, less airborne
    holding, more advance notice when holding is
    required
  • Redistributed, more balanced workload

44
Whos involved
45
McTMA System Architecture
  • The plumbing

46
Airspace Schematic
ZBW
ZNY
PHL
ZOB
ZDC
47
Track flight plan data sources
HOST
ZBW
HOST
ZNY
HOST
PHL
ZOB
HOST
ZDC
48
Individual ARTCC TMA processors
ZBW
ZNY
PHL
ZOB
ZDC
49
McTMA scheduler
ZBW
ZNY
PHL
ZOB
ZDC
50
McTMA scheduler
ZBW
ZNY
PHL
ZOB
ETAs
STAs
ZDC
51
McTMA Timeline graphical user interface
ZBW
ZNY
PHL
ZOB
ETAs
STAs
ZDC
52
McTMA Timeline displays control
ZBW
ZNY
PHL
ZOB
ETAs
STAs
ZDC
53
Whats next?
  • The Game Plan

54
Field trials 1 and 2
January 2003
  • Evaluate each TMA instance in standalone mode
  • Objectives
  • Confirm McTMA installations and network are
    stable
  • Verify internal flight data processing
  • Refine internal ETA computations
  • Collect baseline data
  • Expected result
  • Each TMA node operating stably
  • Reliable flight data processing within each TMA
    and between TMA pairs
  • Accurate partial ETAs

M
T
W
T
F
S
S
1
2
3
4
6
5
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
27
26
28
29
30
31
1
February 2003
M
T
W
T
F
S
S
5
6
7
8
2
3
4
10
9
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
1
55
Field trial 3
  • Transition to full McTMA network
  • Objectives
  • Connect and operate full McTMA network
  • Verify flight data processing
  • Refine end-to-end ETA computations
  • Collect baseline data
  • Expected results
  • McTMA network operating stably
  • Reliable flight data processing throughout the
    McTMA network
  • Accurate end-to-end ETAs
  • TMCs familiar with timeline display, load graph
    display, and basic scheduling panels

March 2003
M
T
W
T
F
S
S
5
6
7
8
2
3
4
10
9
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
31
30
56
Field trials 4 and 5
  • Round 1 operational evaluations
  • Objectives
  • Evaluate candidate operational concepts for
    coordinated arrival planning
  • Conduct human factors assessments
  • Usability, suitability, acceptability
  • Collect baseline data
  • Expected results
  • Accurate demand forecasts
  • Critical review of operational concept candidates
  • User interface design requirements
  • Scheduling performance data collected

April 2003
M
T
W
T
F
S
S
2
1
3
4
5
7
6
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
28
27
29
30
1
2
3
June 2003
M
T
W
T
F
S
S
4
5
6
7
1
2
3
9
8
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
30
29
57
Simulation at WJHTC
  • Objectives
  • Meter competing arrival flows with overflight
    traffic
  • Training
  • Provide cadre with exposure to metering
    operations and techniques in the presence of
    competing arrival flows prior to the start of
    metering trials in the field
  • Illustrate the workload benefits of regulating
    arrival flows using McTMA Illustrate the
    workload costs of poor metering conformance
  • Demonstrate how TMUs at different facilities can
    coordinate their decisions (e.g., departure
    releases) with respect to competing, external
    flows, and thereby avoid holding at their meter
    fix(es)
  • Research
  • Identify the need for requirements changes in the
    McTMA scheduling and/or delay distribution
    algorithms
  • Assess the impact of unscheduled TEC flights

August 2003
M
T
W
T
F
S
S
1
2
6
7
8
9
3
4
5
11
10
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
58
Field trials 6 and 7
  • Round 2 operational evaluations
  • Shadowing
  • Objective
  • Assess McTMA metering performance
  • Activate McTMA advisories for shadowing
  • TMCs use Timeline display to coordinate
    acceptance rates and restrictions
  • Output fed into McTMA for shadowing exercises
  • Controllers shadow the advisories for one
    rush,then debrief
  • Shadow use of departure release tool by TMCs
  • Assess metering advisories and human factors
    issues
  • Collect data for performance metrics

September 2003
M
T
W
T
F
S
S
3
4
5
6
31
1
2
8
7
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
29
28
30
October 2003
M
T
W
T
F
S
S
1
2
3
4
6
5
7
8
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
27
26
28
29
30
31
1
November 2003
M
T
W
T
F
S
S
5
6
7
8
2
3
4
10
9
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
59
Field trials 8 and 9
  • Round 2 operational evaluations
  • Active metering
  • Objective
  • Assess McTMA performance and TFM operations in
    live traffic situations
  • Activate McTMA advisories for live metering of
    PHL arrivals
  • TMCs coordinate acceptance rates and restrictions
  • Controllers use advisories for one rush, then
    debrief
  • TMCs use advisories to issue departure releases
  • Assess McTMA performance and human factors issues
  • Expected results
  • Coordinated, efficient, workable arrival rush
    planning and control

January 2004
M
T
W
T
F
S
S
1
2
3
7
8
9
10
4
5
6
12
11
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
29
30
31
February 2004
M
T
W
T
F
S
S
4
5
6
7
1
2
3
9
8
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
28
March 2004
M
T
W
T
F
S
S
3
4
5
6
29
1
2
8
7
9
10
11
12
13
14
15
16
17
18
19
20
21
22
23
24
25
26
27
29
28
30
31
60
Enough already
  • Thanks for your time and interest
  • For more informationask_mctma_at_osprey.arc.nasa.go
    v
  • better yet, just gimme a call or drop me a
    lineTodd Farley(650) 604-0596todd.c.farley_at_na
    sa.gov
  • See you March 4th
Write a Comment
User Comments (0)
About PowerShow.com
