Academic Analysis of Cost Overruns on Mega Projects - PowerPoint PPT Presentation

1 / 55
About This Presentation
Title:

Academic Analysis of Cost Overruns on Mega Projects

Description:

Downplays or overlooks Organizational Performance - both at the Joint Venture ... Overlooking potential impact of new technology and the inefficiencies and ... – PowerPoint PPT presentation

Number of Views:333
Avg rating:3.0/5.0
Slides: 56
Provided by: kam113
Category:

less

Transcript and Presenter's Notes

Title: Academic Analysis of Cost Overruns on Mega Projects

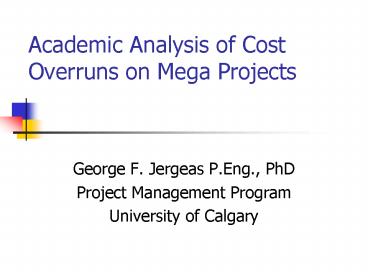

1
Academic Analysis of Cost Overruns on Mega
Projects
  • George F. Jergeas P.Eng., PhD
  • Project Management Program
  • University of Calgary

2
Defining Mega Projects
  • Cost gt 1 billion plus
  • Significant interfaces
  • Many players with different interests
  • Issues risks must be managed at a level above
    the project team
  • Fast tracked

3
The Big Picture
AFE
1
2
3
4
5
PHASE 2 SELECT from Alternatives
PHASE 3 DEVELOP Preferred Alternative
PHASE 4 EXECUTE (Detail EPC)
PHASE 1 IDENTIFY Assess Opportunities
PHASE 5 OPERATE Evaluate
Operate Asset Monitor Evaluate
Performance Identify New Opportunities
Clearly Frame Goal Test for Strategic
Fit Preliminary Overall Plan Preliminary
Assessment 1 Engng. Phase 1 Estimate
Fully Define Scope Develop Detailed Execution
Plans Refine Estimate Submit Funding for
Approval 25 Engng. Phase 3 Est. (/- 10
Accuracy)
Generate Alternatives Preliminary Development of
Alternatives Develop Expected Value Identify
Preferred Alternative Phase 2 Est.
Implement Execution Plan Min. Changes Finalize
Operating Plan Business Plan for Phase
5 Project Review
AFE Appropriation For Expenditure
4
Why Do Mega Projects Fail?
  • Unrealistic estimates?
  • Lack of governance accountability?
  • Appraisal optimism?
  • Is delusion necessary for projects to proceed?
    (re. Flybjerg Mega Projects Risk)
  • Flawed execution plan?
  • Owner role not performed effectively?
  • Poor contractor performance?
  • Doing what weve always done (and expecting
    better results)?

5
Estimating Costs Risks
6
Reasons
  • Size of the project
  • Many resources required
  • Complexity of projects
  • Technological complexity
  • Executed by virtual teams
  • Project organization structure
  • Multiple owners that do not share same culture

7
Reasons
  • JV of Project contractors and engineering firms
    are not aligned
  • Different cultures
  • Need to ensure that their own responsibilities
    are executed as well as possible
  • May be at the expense of the overall project

8
Reasons
  • Unrealistic Expectations
  • The original cost estimate and schedules are for
    project sanctioning, not to provide a realistic
    goal for the project teams
  • Poor/incomplete scope definition i.e. inadequate
    front end loading
  • Poor quality/overly optimistic cost estimates

9
Reasons
  • Contracting strategies
  • Not appropriate for the situation
  • Project control
  • Nobody has single point responsibility except the
    client who does not control much of the work
  • Underestimation/under appreciation of project
    complexity
  • Inadequate plan of execution

10
Reasons
  • Unrealistic schedule
  • Poor project controls
  • Poorly defined tasks and division of
    responsibility
  • Lack of knowledgeable leadership in E, P, C,
    Start-up of major facilities
  • Inexperienced/poorly equipped project management
    personnel and supervisors

11
Reasons
  • Shortage of skilled labour and lower than
    anticipated labour productivity
  • High labour turnover
  • Changing customer requirements
  • Lack of understanding the costs of changes

12
Reasons
  • Poor communication and follow-up
  • Poor site organization leading to excessive time
    wastage
  • Inability to understand, plan, adapt, implement
    procedures or systems

13
The Feasibility Study
  • A very comprehensive document
  • Considerable amount of work to scope the project,
    select the technologies to be used and present a
    business case
  • Lots of time and effort
  • What Owner wanted to do
  • How much it would cost
  • What the economics of the investment would be and
  • What the risks might be

14
The Feasibility Study
  • No sufficient level of detailed work done to
    achieve the level of accuracy and confidence that
    the owners decision makers place in it when a
    project is approved
  • To achieve a level of accuracy of the estimate of
    10-15, we need a 30 engineering completion
  • The right 30 - not just any 30
  • in particular considerable technical information/
    engineering is required from equipment vendors

15
The Feasibility Study
  • Limited input from Operations
  • May be unknown at this time
  • Operations input is invaluable when considering
  • Plant and equipment layout
  • Equipment selection
  • Determining the ongoing operations costs and
    staffing needs
  • Laying out the pre-commissioning and
    commissioning requirements and costs, start-up
    and early production projections.

16
The Feasibility Study
  • Downplays or overlooks Organizational Performance
    - both at the Joint Venture level and at the
    Project level
  • New companies with new and unproven technology in
    industry new to partners
  • Complexity on complexity
  • Benchmarking and Risk Analysis services
  • External reviews
  • Several concerns are usually raised
  • Cost and schedule projections are not
    aggressively challenged

17
The Feasibility Study
  • Not challenged aggressiveness of start-up and the
    production ramp up curves
  • Optimism and a lack of meaningful operations
    input contributes to false hopes on the part of
    the owners
  • Overlooking potential impact of new technology
    and the inefficiencies and problems that could
    result from a new joint venture and sometimes new
    players

18
The Feasibility Study
  • How seriously the project team takes the concerns
    that are raised in the external reviews and
    respond to them?
  • Not referred to at all
  • Acknowledgement of the concerns and with a
    comment that they are being addressed and that
    mitigating actions will be taken.

19
Delays in Engineering
  • Early delays in achieving key milestones such as
  • Substantial Completion of Engineering
  • Freezing Process Flow Diagrams (PFDs)
  • PID issued for design
  • Delays do not seem to be reflected on final
    project completion date
  • Fast-tracking the fast-track!

20
Delays in Engineering
  • A number of development steps
  • Production of PFDs - show the logic of the
    various chemical steps that will be used in the
    new facility.
  • The quantities of each of the process streams
    will be shown
  • Review and approval of owner before the next
    development step is released

21
Delays in Engineering
  • Develop the Process and Instrument Diagrams
    (PIDs)
  • Identify all the pieces of equipment required for
    the process to work
  • Identify all piping required together with
    identification number, size, wall thickness and
    metallurgy, valve locations and type as well as
    control logic and hook-up
  • PIDs contain critical engineering detail that
    must be agreed upon before the construction
    drawings can be started

22
Delays in Engineering
  • Series of extensive reviews before PIDs are
    approved and the detailed discipline engineering
    can begin.
  • PFDs and PIDs Milestones are some of the first
    Milestones and it is only once they have been
    reached that succeeding activities can be
    started.
  • In fact the Engineering build up can only take
    place once these early Milestones have been
    achieved - hence their importance.

23
Delays in Engineering
  • This would put pressure on the completion of the
    succeeding activities.
  • The delay in Engineering can also be caused by
  • Additional work by the steady stream of trends
  • Either adding to original scope or requiring work
    already completed to be re-done
  • Slower build-up of the engineering workforce than
    planned
  • Lower engineering productivity than expected
  • Whatever the reason(s), how do Project Managers
    react?

24
Trend System
  • Changes to the base (AFE) are documented so that
    the potential cost and schedule impact can be
    flagged and estimated.

25
Trend System (cont.)
  • When a trend is raised, the originator has to
    indicate not only the estimated cost but the
    schedule impact of the trend.
  • Early trends would not change the Mechanical
    Completion date
  • PM can mitigate the delays, by adding people ...

26
Trend System (cont.)
  • PM should regularly be assessing the cumulative
    effects on the overall schedule.
  • As the number of trends climbs, one thing is
    certain - more work and more costs are being
    added to the project, and more hours must be
    spent before the project is completed.
  • This means that either the end dates slip or the
    additional work identified will take away from
    the flexibility that was originally in the
    schedule (if any) thus making the probability of
    achieving the schedule less likely

27
Cost Allowances and Contingencies.
  • To cover for design changes, material quantity
    increases
  • Historical and risk based
  • The PM should be running down the allowances
    and contingencies according to some agreed upon
    plan
  • The huge number of trends raised at the early
    stage of a project can provide Warning signal to
    the PM that events are not evolving as expected

28
GOLDEN RULES FOR AN UNSUCCESSFUL PROJECTS
29
  • NEVER prepare a realistic cost and schedule
    estimate

30
Project Estimate
  • NEVER provide a good quality cost estimate
  • Underestimate/under appreciate project complexity
  • Make sure the final completion date is cast in
    stone
  • Be optimistic and any delay during front end or
    engineering will be absorbed by construction!

31
  • NEVER conduct a sufficient Front End Planning

32
Front-end Planning
  • NEVER define the scope of work properly
  • Highly schedule driven
  • Push everything to construction
  • NEVER develop alternatives and then select the
    best alternative
  • NEVER make clear what is in scope and what is out
    of scope
  • NEVER consider a proper risk analysis and
    management with contingencies for both Tactical
    and Strategic risks

33
Strategic Risks
  • Global Risk Examples
  • Broad political uncertainty such as country and
    regional instability or changes of government
  • Product Market issues that affect the spread
    between production costs and product price
  • Project Market issues that affect product and
    service availability or pricing for project
  • Public opposition
  • Global and regional economic trends

34
Strategic Risks
  • Enterprise Risk Examples
  • Quality of Project Delivery System- (Governance,
    People and Systems)
  • General business provisions that limit choice or
    action
  • Partners and issues above the project
  • Issues with the local government
  • Organizational alignment on project goals
  • Scope - (Does the project as represented to the
    project team identify every element that will
    eventually be required?)

35
Tactical Project Risks
  • Definition (Degree of scope definition in
    relation to stage of project)
  • Contracting strategy effectiveness
  • Front End Loading effectiveness
  • Issues with compliance with local government laws
    / requirements
  • Effectiveness of Management of Change
  • Materials identification and management
  • Logistics risks
  • Procurement (pricing) risks
  • Engineering Productivity and schedule adherence
  • Construction Productivity and schedule adherence
  • Site related risks

36
Categorize Project Risks to Better Understand Them
Authority / Accountability
Management
  • e.g.
  • Management intervention in PMT tactics leads to
    internally driven risks
  • e.g.
  • Political
  • Global economic trends
  • Partner / NOC issues
  • Organizational alignment
  • e.g.
  • Project definition
  • Contractor performance
  • Pricing
  • Logistics
  • e.g.
  • Unmitigated strategic risks become tactical
    problems for PMT

PMT
Tactical Strategic
Risk
37
  • NEVER develop an appropriate contract strategy

38
Contract Strategy
  • NEVER break the Project to Manageable chunks
  • NEVER select the right contractual arrangement
    and payment structure
  • Always adopt fast-track strategy
  • With Lump sum combination
  • On Mega Oil Sands Projects adopt a cost plus
    approach
  • ALWAYS ASSUME that
  • Multiple owners share same culture
  • JV of contractors and engineering firms are
    aligned and set up to work effectively

39
  • NEVER apply a proper project control system re
    schedule, cost, safety, quality

40
Project Control
  • NEVER make clear who has single point of
    responsibility
  • NEVER freeze the design
  • NEVER worry about early warning signs such as
    number of trends, changes, consumption of
    contingency and project float
  • NEVER pay attention to interface management

41
  • NEVER pay attention to labour productivity

42
Construction Productivity
  • NEVER consider the following
  • Labour relations and morale
  • Communications
  • Material
  • Equipment
  • Scaffolding
  • Subcontractors
  • Supervision and leadership
  • Overtime and acceleration
  • Workface planning

43
  • NEVER FAMILIARIZE YOURSELF WITH THE CONTRACT

44
ALWAYS ASSUME
  • CONTRACT JUST LIKE OTHERS
  • MUST BE FAIR and reasonable

45
No Damage for Delay
  • The contractor shall not have any claim for
    compensation for damages against the owner for
    any stoppage or delay from any cause whatsoever.

46
  • NEVER IDENTIFY SCHEDULE EFFECT

47
Never document delays and impacts Never request
appropriate extension of time Never make clear
who pays for additional costNever make clear
who pays for acceleration
48
  • NEVER QUALIFY YOUR CHANGE ORDER PRICE

49
ALWAYS ALLOW OWNER TO ASSUME PRICE OF CHANGE
ORDER INCLUDES
  • SCHEDULE EFFECT
  • IMPACT ON CONTRACT WORK
  • CUMULATIVE EFFECT
  • PRODUCTIVITY IMPACT

50
NEVER WAIT FOR WRITTEN AUTHORIZATION BEFORE
PROCEEDING WITH A CHANGE
51
ALWAYS
  • ASSUME People are fair and reasonable
  • Time is of the essence
  • Engineers and contractors focus on getting the
    work done!!

52
  • NEVER MAINTAIN PROPER JOB RECORDS

53
PROPER RECORDSMIGHTALLOW YOU TO JUSTIFY
QUANTIFY THE REQUEST FOR ADDITIONAL
COMPENSATIONTHIS SHOULD BE AVOIDED!
54
  • NEVER READ AND IF NECESSARY OBJECT TO MINUTES OF
    MEETINGS

55
Thats all and thank you
