William Keese Chairman - PowerPoint PPT Presentation

1 / 19
About This Presentation
Title:

William Keese Chairman

Description:

New transmission undermined by financial uncertainty, not necessarily permitting ... by Jack Davis, Pinnacle West, and Marsha Smith, Chair of CREPC, delivered the ... – PowerPoint PPT presentation

Number of Views:39
Avg rating:3.0/5.0
Slides: 20
Provided by: dougl45
Category:

less

Transcript and Presenter's Notes

Title: William Keese Chairman

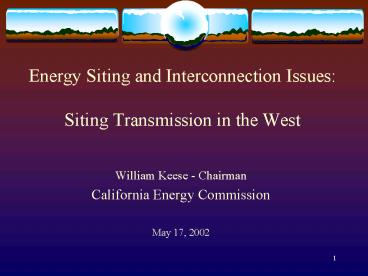

1
Energy Siting and Interconnection IssuesSiting
Transmission in the West
  • William Keese - Chairman
  • California Energy Commission
  • May 17, 2002

2
Siting Transmission in the West
  • Increased regionalization of power markets under
    industry restructuring has placed bulk
    transmission system in the spotlight
  • Major Western urban centers experiencing rapid
    demand growth, exacerbating some transmission
    constraints
  • New transmission undermined by financial
    uncertainty, not necessarily permitting
    uncertainty

3
Siting Transmission
  • Right way
  • Interconnection-wide planning process
  • Necessary to provide sound basis for evaluating
    alternatives
  • Necessary to secure financing
  • Regional siting protocol
  • Ensure state collaboration
  • Ensure federal agencies participate
  • Wrong way
  • Allow FERC to preempt states
  • Remove decisions to distant federal bureaucracy
    (FERC) that is
  • Unfamiliar with conditions
  • A single purpose agency
  • Has no expertise in siting

4
(No Transcript)
5
Western Record on Transmission Siting
  • Little new transmission has been proposed due to
  • New generation being located closer to load
  • Uncertainty created by federal open access
    policies
  • No state in the Western Interconnection has ever
    denied a permit for an interstate transmission
    line
  • Major challenge to permitting new transmission in
    the West is the federal government
  • This may also be true in the East

6
Collective Actions of Western Governors
  • December 2000 Emergency meeting in Denver
  • February 2001 WGA Energy Roundtable
  • May 2001 Transmission Roundtable
  • August 2001 Conceptual Transmission Plans
    report and adoption of Energy Policy Roadmap
    resolution
  • Fall 2001 - Communications with Administration
    and Congress on concept of FERC eminent domain
  • February 2002 Transmission financing report
  • April 2002 Environmental Summit review of
    permitting protocol

7
Western Transmissions Roundtable
  • In May 2001, Western governors held a
    transmission roundtable and asked
  • What new transmission is needed?
  • How can needed transmission be financed?
  • How can needed transmission be expeditiously
    permitted?

8
What transmission is needed?
  • In May 2001, Governors formed a broad
    stakeholder committee to develop a Conceptual
    Transmission Plans report for the West
  • The committee, headed by Jack Davis, Pinnacle
    West, and Marsha Smith, Chair of CREPC, delivered
    the report in August 2001
  • The Conceptual Transmission Plans report is at
    http//www.westgov.org/wga/initiatives/energy/tran
    smission_rpt.pdf

9
Two Transmission Need Scenarios
  • Study looked at two bookend scenarios
  • Load growth over next 10 years met by gas-fired
    generation close to load centers
  • Load growth not covered by plants under
    construction (25,000 MW) would be met with remote
    coal, wind, geothermal and hydro resources

10
(No Transcript)
11
(No Transcript)
12
Five Principles from the Study
  • Any expansion of the transmission system must
    maintain reliability, support both load and
    resource diversity in the Western
    Interconnection, and enable an efficient
    wholesale electric market.
  • Transmission pricing and cost recovery should
    provide incentives for regionally beneficial
    expansion and system improvement.
  • A forward-looking Western interconnection-wide
    transmission planning process should be
    established.

13
Principles (contd)
  • Transmission should enable access to more
    economical and less-polluting resources, thereby
    minimizing environmental impacts on both a local
    and regional basis.
  • All siting review processes must be streamlined
    and coordinated. State review processes should
    address both local and interconnection-wide
    needs, and federal agency review processes must
    be coordinated internally as well as with state,
    tribal and local authorities.

14
How can needed transmission be financed?
  • In August, the governors established a second
    group to develop a white paper on transmission
    financing
  • Two basic models
  • Total system cost
  • Market-based
  • Passionate disagreements on models
  • Agreement on need to undertake proactive
    transmission planning to make either financing
    mechanism work

15
How can needed transmission be expeditiously
permitted?
  • In August, governors directed the development of
    a protocol among states to collaborate in the
    review of proposed interstate transmission
  • Recognition of regionalization of power markets
  • Build on cooperative efforts among states and
    provinces in the Western Interconnection

16
Evolution of Protocol
  • August 2001 governors directed development of
    protocol
  • October 2001 CREPC reviews first draft
  • December 2001 governors direct addition of more
    detail and efforts to include federal land
    management agencies
  • March 2001 WGA Chair asks DOI, USDA and DOD to
    join protocol

17
Evolution of Protocol (contd)
  • April 2001 Protocol vetted with diverse
    stakeholders in the West at WGA Environmental
    Summit
  • Stakeholders find protocol workable
  • Need for proactive transmission planning process
    highlighted
  • BLM and Forest Service indicate willingness to
    join protocol

18
Next Steps on a Western Protocol
  • Revise language
  • Submission to governors by end of May
  • Governors sign protocol in June

19
Stakeholder Findings
  • Collaborative draft protocol will work.
  • BLM/FS ready to participate (except need).
    Protect confidentiality, reassess deadlines,
    avoid delays.
  • DOD, EPA, FERC, USFWS, DOE should consider
  • Include mechanism for public in project teams
  • Include line upgrades and line maintenance
  • Digitize, standardize and publish information
  • Need regional planning process that precedes
    protocols project-by-project review process
  • Determine need (including generation location)
  • Clarify who should pay for new transmission
  • Recognize constraints from existing
    infrastructure and processes (e.g., existing
    corridors)
  • Protocol and planning process should provide
    predictability and certainty.
