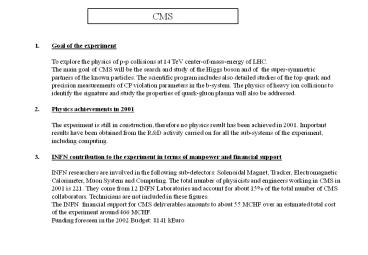

CMS
  • Goal of the experiment
  • To explore the physics of p-p collisions
    at 14 TeV center-of-mass-energy of LHC.
  • The main goal of CMS will be the search and
    study of the Higgs boson and of the
    super-symmetric
  • partners of the known particles. The scientific
    program includes also detailed studies of the top
    quark and
  • precision measurements of CP violation
    parameters in the b-system. The physics of heavy
    ion collisions to identify the signature and
    study the properties of quark-gluon plasma will
    also be addressed.
  • Physics achievements in 2001
  • The experiment is still in construction,
    therefore no physics result has been achieved in
    2001. Important results have been obtained from
    the RD activity carried on for all the
    sub-systems of the experiment, including
    computing.
  • INFN contribution to the experiment in terms of
    manpower and financial support
  • INFN researchers are involved in the following
    sub-detectors Solenoidal Magnet, Tracker,
    Electromagnetic Calorimeter, Muon System and
    Computing. The total number of physicists and
    engineers working in CMS in 2001 is 221. They
    come from 12 INFN Laboratories and account for
    about 15 of the total number of CMS
    collaborators. Technicians are not included in
    these figures.
  • The INFN financial support for CMS deliverables
    amounts to about 55 MCHF over an estimated total
    cost of the experiment around 466 MCHF.
  • Funding foreseen in the 2002 Budget 8141 kEuro

2
  • Number of publications in refereed journals
  • 30
  • Number of talks to conferences (from INFN)
  • 20
  • Number of undergraduate and doctoral thesis on
    the experiment
  • 17 undergraduate students and 6 doctoral thesis
  • Leadership role in the experiment
  • - Lorenzo Foa Chairman of the
    Collaboration Board
  • - Fabrizio Gasparini Project Leader (Muon)
  • - Rino Castaldi Deputy Project Leader
    (Tracker)
  • - Cristiana Peroni Finance Board
  • - Guido Tonelli Management Board and Finance
    Board
  • Innovative instruments
  • 4T magnet large area RPCs radiation-hard
    silicon detectors and read-out electronics
    analog optical links new crystals and APDs new
    approach on trigger, data handling and computing.


3
Milestones 2001
  • MAGNET
  • Winding of the prototype July
  • Completion of CB-2 module December
  • RPC
  • Production of front-end chips July
  • Production of front-end boards September
  • Production of 70 of stations of the 1st
    wheel December
  • ECAL
  • Construction of the 1st module in INFN/ENEA
    RC December
  • Production and test of module 0 December
  • MUONS DT
  • Completion of production lines in LNL March
  • 5 DT chambers produced June
  • Completion of the tender for trigger ASICs (BTI,
    BTIM) October
  • 15 DT chambers produced December

4
Milestones 2002
  • MUONS
  • 8 MB3 May
  • Further 8 MB3 October
  • Production lines in Torino ready September
  • Assembly test of the first mini-crate October
  • RPC
  • Decision on mass production January
  • Production and test of the front end chips
    February
  • Production stations 2 and 3 CW June
  • HV system prototype ready July
  • Production and test of all FE boards September
  • Production station 1 CW October
  • ECAL
  • Quality check on 2000 crystals June
  • Quality check on 6000 crystals (20 of the
    total) December
  • Assembly and test of 5 modules June
  • Assembly and test of 12 modules (15 of the
    total) December
  • Test of 12 HV boards June

5
Milestones 2002
  • TRACKER
  • 40 modules M200 produced January
  • System test (6 modules in a string) March
  • Final specifications optical hybrid May
  • Start-up of module production June
  • Final specifications Power Supply October
  • 400 modules produced December
  • Layer 1 mechanical structure December
  • MAGNET
  • Impregnated prototype ready January
  • Module CB-2 impregnated April
  • Module CB-1 impregnated July
  • Module CB0 impregnated October
  • COMPUTING
  • All sites operational March
  • One half of the sites working in integrated
    mode April
  • Test of Data Base distribution within
    sites June
  • 4 Tier2 initial prototypes ready October
