A Utah experience with CMGC - PowerPoint PPT Presentation

1 / 24
About This Presentation
Title:

A Utah experience with CMGC

Description:

Highest Point: King's Peak 13,528 ft. Lowest Point: Beaver Dam Wash 2,350 ft ... UDOT helps steer innovation. Reduce design errors. Improved Constructability ... – PowerPoint PPT presentation

Number of Views:252
Avg rating:3.0/5.0
Slides: 25
Provided by: jmcmi
Category:
Tags: cmgc | experience | steer | utah

less

Transcript and Presenter's Notes

Title: A Utah experience with CMGC


1

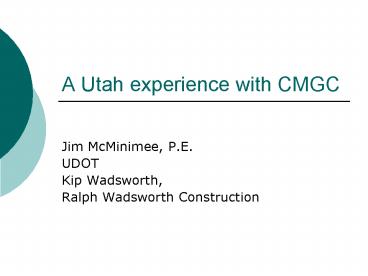

A Utah experience with CMGC
  • Jim McMinimee, P.E.
  • UDOT
  • Kip Wadsworth,
  • Ralph Wadsworth Construction

2
CMGC
  • Why?
  • What it is
  • The process we use
  • Benefits and Risks
  • Where are we headed?
  • Case Study

3
Utah Statistics
  • Population 2,233,169 (2000 Census)
  • Land Area 84,916 sq. miles
  • Highest Point Kings Peak 13,528 ft
  • Lowest Point Beaver Dam Wash 2,350 ft
  • 2nd most Urbanized population

4
Dollars in Volume
  • 1996 - 450 Million Federal Aid program
  • 1997 5.5 cent State Gas tax funds 3.2B
    (290/yr)
  • 2007 1.4B General fund (1B bond) next 2-3 yrs
    (700 to 500/yr)
  • 143 projects 1.1B under construction right now
  • 2008?
  • Program Growth required changes in project
    delivery

5
Upcoming Innovative Program
6
Innovations to Reduce Project Delivery Time
Design Build
ABC
CMGC/CM at Risk
Total Closure
AB
Lane Rental
7
Traditional Cost Curve for Construction Projects
8
User Costs vs. Time in Work Zones
9
Project Cost Curve
Construction User
Lowest Cost Project
Lowest Construction Cost
10
Innovative Methods Learning Curve
11
How does Innovative Delivery work?
DB/CMGC/ABC
Partnership involves entire industry
12
CMGC What is it?
  • Two part contracting method
  • Part one Construction Management
  • Part two General Contractor
  • Part one
  • Work with Owner, and Designer to design Job
  • Provide advice on Constructability, Schedule,
    Materials, Budget
  • Bid on project
  • Part two-
  • Build project

13
CMGC process
  • Owner hires Designer and CMGC contractor
  • CMGC contractor hired with Best Value selection
    the earlier the better
  • UDOTS selection criteria has Experience, Project
    Approach, Price, and Approach to Price
  • Team works on design
  • Periodically owner asks CMGC to price job
  • UDOTs model has two estimates- Designer
    furnishing Engineers estimate, and an Independent
    Cost Estimate (ICE)
  • Iterations address risk

14
CMGC process (cont)
  • Two possible outcomes of bid
  • Owner gets acceptable price
  • Proceed with build
  • Owner doesnt get acceptable price
  • Proceed with more design ultimately convert to
    Design-Bid-Build
  • Build contract can be Guaranteed Max price or
    Unit price

15
Risk
16
What Does UDOT expect from CMGC?
  • Better Designs
  • Better schedules
  • Lower costs
  • Savings in design
  • Savings in constructability
  • Savings in innovation

17
CMGC Benefits
  • UDOT Benefits
  • UDOT collaborates in design
  • UDOT helps steer innovation
  • Reduce design errors
  • Improved Constructability
  • Less detail required in design
  • Identify and manage risk
  • Early Procurement
  • Early start on critical path
  • Contractor Benefits

18
CMGC Risks
  • UDOT Risks
  • Sole source contract
  • Unable to negotiate on project cost (schedule)
  • New process
  • Contractor Risks

19
Strategy for CMGC
  • Projects where UDOT needs Contractor involvement,
    but desires to control design
  • Projects with high need for innovation
  • Projects that can benefit from early procurement
  • Projects with third-party risk or unknowns

20
CMGC PROGRAM
  • 15 projects
  • Dollar Volume
  • Draft Report for FHWA

21
Case Study 4500 south Bridge Replacement
  • Working with the Contracting Industry to deliver
    projects quickly
  • Uses CMGC and ABC
  • Rapid Bridge replacement

22
Project Timeline
  • Design Bid Build
  • January 2007 - Begin design
  • September 2007 - Advertise project
  • Fall 2008 - Construction completion
  • CMGC
  • January 2007 - Began preliminary design
  • March 2007 - Hired contractor
  • Fall 2007 - Construction completion

23
Success!
  • Interstate traffic closed only 52 hours
  • Decreased construction impacts from months to
    hours
  • Opened interstate 6 hours earlier than expected
  • Saved 4 million in user costs
  • Future plans to build using this innovation
  • I-80
  • Parleys Canyon
  • 33rd south, I-215

24
Questions?
Write a Comment
User Comments (0)
About PowerShow.com
