MITTAL STEEL SOUTH AFRICA CAPITAL PROJECTS INFORMATION DAY - PowerPoint PPT Presentation

1 / 32
About This Presentation
Title:

MITTAL STEEL SOUTH AFRICA CAPITAL PROJECTS INFORMATION DAY

Description:

10:00 10:15 Opening and welcoming by the CEO ... Transport and cranes. 16. Raw Material Handling. Extend Fine Material Blending bed by 150 m ... – PowerPoint PPT presentation

Number of Views:197
Avg rating:3.0/5.0
Slides: 33
Provided by: auth181
Category:

less

Transcript and Presenter's Notes

Title: MITTAL STEEL SOUTH AFRICA CAPITAL PROJECTS INFORMATION DAY

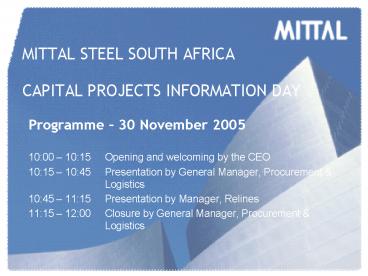

1
MITTAL STEEL SOUTH AFRICACAPITAL PROJECTS
INFORMATION DAY
  • Programme 30 November 2005
  • 1000 1015 Opening and welcoming by the CEO
  • 1015 1045 Presentation by General Manager,
    Procurement Logistics
  • 1045 1115 Presentation by Manager, Relines
  • 1115 1200 Closure by General Manager,
    Procurement Logistics

2
Todays discussion
  • Mittal Steel South Africa Strategic Goals and
    Throughput Strategy
  • Overview of Capital Projects planned by Mittal
    Steel South Africa Limited (2006 2010)
  • Blast Furnace D Reline 2006
  • BEE and areas of concern

3
Strategic Goals and Throughput Strategy of Mittal
Steel South Africa
4
Strategic Goals
  • Industry leading value-creation for our
    shareholders
  • - Positive EVA over the cycle
  • Improve operating Capabilities
  • - Value-creating throughput increases of 2 Mtpa
  • - 20 reduction in HRC/billet cash cost by 2007
  • Build a high performance culture
  • - Create an environment that generates true
    employee pride attracts, develops retains
    top-performing people
  • Be a responsible corporate citizen

5
Throughput Strategy
  • Increase production by 1,5 Mtpa by end 2007
    with initial capex
  • - 325 ktpa 2 new DRI kilns at Vanderbijlpark
    by 2H/07
  • - 660 ktpa efficiency improvements by 2H/06
  • - 445 ktpa Blast furnace D reline at
    Vanderbijlpark by 2H/06
  • - Expand sinter capacity at Vanderbijlpark by
    1H/08
  • Utilize opportunities to increase throughput by
    further 1Mtpa with capital expenditure
  • - 505 ktpa Additional DRI kilns at
    Vanderbijlpark by 2H/09
  • - 355 ktpa Blast Furnace C reline at
    Vanderbijlpark by 2012
  • - 105 ktpa Smaller capital projects at
    Saldanha and Vereeniging
  • Rationalization of other facilities to follow

6
Overview of Capital Projects planned by Mittal
Steel South Africa Limited(2006 2010)
7
Distribution per Geographical area
8
Vanderbijlpark Steel
  • An overview of the projects planned at
    Vanderbijlpark Steel is the following
  • 30 Projects gt R 20m
  • 17 Projects R10m to R20m
  • 200 Projects lt R10m

9
Saldanha Steel
  • An overview of the projects planned at Saldanha
    Steel is the following
  • 8 Projects gt R20m
  • 5 Projects R10m to R 20m
  • 90 Projects lt R10m

10
Newcastle Steel
  • An overview of the projects planned at Newcastle
    Steel is the following
  • 14 Projects gt R20m
  • 11 Projects R10m to R 20m
  • 80 Projects lt R10m

11
Vereeniging Steel
  • An overview of the projects planned at
    Vereeniging Steel is the following
  • 6 Projects gt R20m
  • 4 Projects R10m to R 20m
  • 110 Projects lt R10m

12
Mittal Coke Chemicals
  • An overview of the projects planned at Mittal
    Coke Chemicals is the following
  • 2 Projects gt R20m
  • 5 Projects R10m to R 20m
  • 96 Projects lt R10m

13
Overview on 2 new DRI Kilns 5 6 and additional
sinter strand
14
Kiln 5 6 Project ScopeThe project is an
integral part of our expansion strategy and
consists of five main components
  • Material Handling
  • Raw Materials Handling
  • Product Handling
  • Ash Handling
  • Kiln and Cooler Proper (2 off)
  • 80 m Kiln, 4.8 m diam
  • 50 m Cooler, 3.2 m diam
  • After Burner Chamber (ABC) and Dust Settling
    Chamber (DSC)
  • Various bought out items fans,motors,gearboxes,p
    umps.
  • 66 Bar Waist Heat Boilers (2 off)
  • Electrostatic Precipitators (2 off)
  • Power Plant (Turbo Alternator Set)

15
Kiln 5 6 Project Activities
  • Design
  • Project Management of total or portions of
    project
  • Site establishment
  • Civil Construction
  • Electrical supply and control equipment
  • Various bought out items fans, motors,
    gearboxes, pumps.
  • Erection of buildings, kiln and coolers, Boilers,
    ESP
  • Transport and cranes

16
Sinter Upgrade Project ScopeThis project is an
integral part of the expansion strategy and
consists of the following elements.
  • Raw Material Handling
  • Extend Fine Material Blending bed by 150 m
  • Install new Tippler
  • Install raw material buffer facility
  • New conveyors ca 2500 m
  • Sinter Plant proper
  • 159 m² Sintering area, 130 pallet cars
  • Off strand rotary Cooler
  • Extend cold screening, crushers and screens
  • 4 x 400 m3 steel bins and mixing drum
  • Various bought out items fans,motors,gearboxes,p
    umps.
  • Install extra power supply capacity ca 20 MWh

17
Blast Furnace D Reline 2006
18
Blast Furnace D Reline 2006
  • Index
  • Objective of reline
  • Background
  • Overview of scope

19
Blast Furnace D Reline 2006Objective of Reline
  • Campaign life of 20 years.
  • Minimum downtime - 90 days.
  • Production capacity 5700tHM/day after sinter
    plant increased production.
  • An improved hot metal quality level and lower
    standard deviation with respect to hot metal
    silicon, sulphur and temperature.
  • Increased availability

20
Blast Furnace D Reline 2006Background
  • Blast Furnace D was relined in 1990 and since
    then it has received 3 intermediate repairs
  • In 1997 the refractory material in the hearth
    walls, the bosh, the belly of the furnace, and
    the ceramic burners in all hot blast stoves were
    replaced
  • In 2000 the refractory material in the lower
    shaft, the throat armour, part of the furnace
    shell and three segments of the bustle pipe were
    replaced
  • In 2004 the cooling elements in the lower shaft
    were replaced with staves, the furnace was
    shotcreted, a water cooled under hearth system
    was installed and the Paul Wurth gearbox was
    replaced

21
Blast Furnace D Reline 2006Background
  • The project will be handled in the following
    phases
  • Phase 0
  • Conceptual study completed
  • Phase 1
  • Fixing of scope and budget - completed
  • Phase 2
  • Engineering and procurement - present
  • Phase 3
  • Reline start 1 July 2006
  • Phase 4
  • Project closure

22
Blast Furnace D Reline 2006Overview of Scope
  • Stockhouse and Furnace Charging
  • Furnace Proper
  • Casthouse
  • Raw Gas System
  • Electrical, Instrumentation Control

23
Blast Furnace D Reline 2006Overview of Scope
  • Stockhouse and Furnace Charging
  • Refurbish existing equipment
  • Increase coke storage capacity from 5 hours to
    12 hours
  • Replace the redundant skip charging system with
    a conveyor charging system
  • Install an additional dust extraction system

24
Blast Furnace D Reline 2006Overview of Scope
  • Furnace Proper
  • Replace the complete furnace shell as the
    existing bottom plate is cracked
  • Replaced the furnace hearth refractory material
  • Install a copper and cast iron staves cooling
    system
  • Install a closed cooled water system
  • Replace damaged uptakes
  • Replace the bustle main on a new elevation

25
Blast Furnace D Reline 2006Overview of Scope
  • Casthouse
  • Increase the length of the iron troughs
  • The cast house floor will be leveled for mobile
    access
  • Install a ramp from ground level to the cast
    house floor
  • Install air cooled troughs
  • Install a new tuyere platform
  • Install new slag runners to accommodate a new
    casthouse layout

26
Blast Furnace D Reline 2006Overview of Scope
  • Raw Gas System
  • Replace the primary dust catcher internal
    trumpet
  • Replace the dust discharge equipment
  • Refurbish the existing gas scrubber
  • Install a new cooling tower

27
Blast Furnace D Reline 2006Overview of Scope
  • Electrical, Instrumentation Control
  • Supply new electrical system for all new
    equipment
  • Refurbish existing electrical systems

28
BEE and Areas of Concern
29
BEE Policy
  • Realising that Black Economic Empowerment (BEE)
    are the cornerstone of a strong and sustainable
    economy, Mittal Steel South Africa Ltd commits
    itself to actively support and contribute to the
    development and growth of BEEs in the Republic
    of South Africa.
  • We believe that the active development and the
    participation of BEEs will ensure broad based
    growth of the economy and the achievement of
    sustainable development, job creation and general
    prosperity in our country.
  • A BEE policy is in place that will enable Mittal
    Steel South Africa Ltd and its employees the
    opportunity to contribute effectively to a better
    South Africa.
  • Mittal Steel South Africa Ltd commits itself to
    pursue and actively promote this process.

30
The objectives of the BEE policy
  • To facilitate access of BEE Vendors, to Mittal
    Steel South Africa Ltd procurement activities
  • To contribute to development and growth of BEE
  • To establish, monitor and report progress against
    annual targets for goods/services procured
  • To encourage major non-BEE vendors to establish
    and implement BEE initiatives
  • The following shall not be compromised in the
    process of giving effect to this policy
  • The expertise and experience of persons supplying
    services
  • The specifications and quality of goods to be
    supplied
  • Delivery reliability
  • Pricing

31
BEE Management
  • Preferential treatment of BEE vendors
  • In the process of awarding tenders by Mittal
    Steel South Africa Ltd, preference shall be given
    to BEE Vendors who meet all the tender
    requirements.
  • Mittal Steel South Africa Ltd spend R1,023
    Billion on BEE suppliers in 2004
  • Projected spend on BEE suppliers for 2005 will
    be R 1,615 Billion
  • During 2006 Mittal shall align its supplier
    database with the new codes of Good Practice as
    determined by the DTI

32
Areas of Concern
  • General skills shortage in the country due to
    Engineers and artisans seeking international
    employment during the last 10 years
  • Infrastructure and other expansion projects in
    South Africa sucking up most of the Engineering,
    Project Management and Manufacturing Capacity
  • Delivery Reliability due to the tight
    deadlines, commitments to equipment delivery and
    commissioning of projects must be adhered to at
    all times
  • Sub-contracting of work Mittal Steel SA Ltd
    conduct business with reliable vendors that are
    capable of rendering a quality, affordable and
    timely service. In the event of subcontracting
    work, main contractors should verify the
    capabilities of sub-contractors to perform the
    work
  • Safety of contractors high activity at the
    business units due to capital expansions leads to
    a higher safety risk. Proof of section 16.1 or
    16.2 responsible person appointments in terms of
    the OSHACT is compulsory
