Coastal Water Project - PowerPoint PPT Presentation

1 / 32
About This Presentation
Title:

Coastal Water Project

Description:

Floor Slabs, Foundations, and Hydraulic Structures were estimated at $1100/ CY ... Project Administration and Management, Engineering, Legal ... – PowerPoint PPT presentation

Number of Views:57
Avg rating:3.0/5.0
Slides: 33
Provided by: MSHA8
Category:
Tags: coastal | project | water

less

Transcript and Presenter's Notes

Title: Coastal Water Project

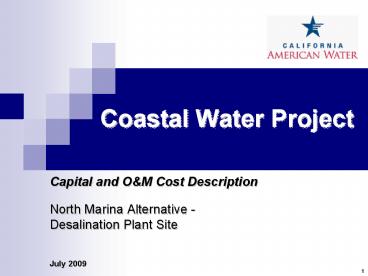

1
Coastal Water Project
  • Capital and OM Cost Description
  • North Marina Alternative -
  • Desalination Plant Site

2
Introduction
  • Present cost estimates for North Marina Project
    Alternative
  • including key assumptions and approach
  • Workshop Presenters
  • Mark Schubert, PE, CAW
  • Paul Findley, PE, RBF Consulting
  • Dave Stephenson, CAW
  • Data and assumptions derived from cost estimates
    contained in Attachments K and L of the Schubert
    Testimony, dated May 22, 2009

3
North Marina Project
  • First Proposed in PEA, 2005
  • Basic Components, per DEIR
  • 11 mgd Desalination Plant in North Marina
  • Sourced from Slant Wells
  • Return up to 800 afy to water users in Salinas
    Valley
  • Brine Disposal to MRWPCA Outfall
  • Pipelines to CAW Service Area
  • Terminal Reservoir
  • Pump Station and Pipeline to ASR Wells
  • 2 New ASR Wells 2 Existing ASR Wells

4
North Marina Project (contd)
  • Cost Estimate History
  • Capital Costs
    Annual OM Costs
  • PEA 214M 7.8M (gross)
  • (2005 ) (for 11,730 afy)

  • Current 250M 9.6 -10.1M (gross)
  • (2009 ) 7.6M-8.1M (net)

  • (for 10,100-10,900 afy)

5
North Marina Cost Estimates
  • Changes, Compared to PEA Estimate
  • Updated to 2009 dollars (from 2005 dollars),
    checked previous estimates, and added more detail
  • Slant well intakes instead of HDD well intakes
  • 11mgd desalination plant capacity, instead of 10
    mgd
  • Added facilities for delivery of up to 2 mgd to
    CSIP system
  • Brine disposal to MRWPCA Outfall instead of MLPP
    Outfall

6
North Marina Cost Estimates (Contd)
  • Changes, Compared to PEA Estimate
  • Added pressure dual media filters
  • Added 20 RO standby capacity
  • Incorporated same system changes as Moss Landing
    Project, south of Reservation Road
  • OM costs estimated at meeting 15,200 afy total
    CAW system demand plus 800 afy to CSIP
  • Assumed power from grid instead of self-generation

7
Capital Cost Estimate
ML Moss Landing NM North Marina X Both Sites
8
Pipelines
  • Cost Components
  • Material
  • Adjusted Vendor Quotes for Pipes
  • Type II Asphalt Concrete
  • Erosion Control (BMP)
  • Labor Equipment
  • ROW Preparation, Pipeline Installation, Erosion
    Control, Surface Restoration, Bore Pit
    Construction
  • Prevailing Wages per Department of Labor
  • Variable Production Rates for Standard Crews
  • Off-site Transport and Storage of Excavated
    Material
  • Required Equipment per Construction expert

9
Pipelines (contd)
  • Special Construction
  • 1,500/ LF for Jack and Bore
  • Dewatering Wells 32,000 per Jack and Bore
    Crossing
  • Cathodic Protection
  • 5/ LF for metallic pipelines
  • Contractor Overhead Profit (OHP)
  • 18.5 of all above costs

10
Pump Stations
  • Desalinated Water PS ASR PS
  • Quantity estimates and unit prices per recent
    similar project estimate
  • All Other Pump Stations
  • Equipment estimated on / Installed HP, plus 25
    for taxes, installation, material, plus 18.5
    for contractor OHP
  • Building based on 110/ SF, includes contractor
    OHP
  • Wet wells based on 700/ CY of concrete

11
ASR Wells
  • Monitoring Well, Core, Test well at ASR Well 3
  • Test Well at ASR Well 4
  • Stainless Steel Material for Test Wells
  • Wellhead facilities at ASR Wells 3 4
  • Conversion of Test Wells to Production wells
  • Well Pumps
  • Electrical Pump Building
  • Well Field Piping Civil Work
  • Electrical, IC
  • Back flush Water Reclamation Facility
  • Estimates from ASR Systems
  • Contractor OHP included in above

12
Slant Wells
  • Test Slant Well 5 Additional Production Slant
    Wells
  • 13.8 million, Including contractor OHP
  • Slant Well Drilling costs detailed by Doheny
    State Beach Slant Well Driller
  • Stainless Steel Material
  • Includes
  • Well Pumps Installation
  • Well Development Testing
  • Testing / Development Water Disposal facility
  • Civil works and well head vaults
  • Electrical, IC
  • Electrical Costs Include additional 250,000 for
    upgraded service to site

13
Process Equipment
  • Cost Components
  • Vendor Supplied Equipment
  • RO System, Pressure Filters, Pumps, Screens,
    Chemical Systems
  • Includes Delivery, Taxes, Manuals, Testing,
    Training
  • Installation
  • Includes Labor, Equipment, Contractor Supplied
    Appurtenances
  • Estimate based on expert consultation and
    experience
  • Building, Electrical, IC, and Site Work
  • Estimated Separately
  • Contractor OHP
  • 10 for RO Equipment
  • 18.5 for other installed equipment
  • The North Marina RO Process Facility cost was
    developed by multiplying the Moss Landing RO
    Process cost by a factor of 1.10

14
Buildings Structures
  • Floor Slabs, Foundations, and Hydraulic
    Structures were estimated at 1100/ CY
  • Superstructures were estimated at
  • 120/ SF for large process buildings
  • 110/ SF for pump stations
  • 350/ SF (first floor area) for two story admin
    building
  • Detailed estimates for buildings were estimated
    using commercially available cost estimating
    software

15
Civil Works
  • Line Items in the Estimate
  • Desalination Plant Earthwork, Sitework, Piping
  • Terminal Reservoir Earthwork, Sitework, Piping
  • ASR Backflush Reclamation Basin
  • Dried Solids Storage
  • RO Clean in Place (CIP) Waste Storage

16
Civil Works (contd)
  • Unit Costs
  • General Site work 5/ SF
  • Site Preparation
  • Rough Grading
  • Fine Grading
  • Paving
  • Landscape Irrigation
  • Site Lighting Security
  • Fencing
  • Excavation / Backfill 7/ CY
  • Yard Piping 400/ LF
  • Above Costs Include 18.5 Contractor OHP

17
Tanks (Reservoirs)
  • Circumferentially Pre-stressed, Post-Tensioned
    Concrete Tanks w/ Concrete Covers
  • Partially Buried Clearwell 1.75/ gallon
  • Clearwell at Moss Landing 1.50/gallon
  • Buried Terminal Reservoir 1.75/ gallon
  • Costs Include 18.5 Contractor OHP
  • Earthwork, Site work, and Piping estimated
    separately
  • Based on analysis of two similar recently
    constructed projects

18
Electrical, Instrumentation Control (IC)
  • Desalination Plant Electrical /IC
  • Power intensive facility
  • Allowance of 25 of other plant non-electrical
    costs, based on recommendation from electrical
    engineering expert
  • Includes plant control systems, and SCADA system
    for remote communications and control
  • Other Facilities Electrical /IC
  • Allowance of 5 to 15 of facility non-electrical
    costs, depending on power intensity of facility
  • Includes connection to SCADA system

19
Property
  • Site Acquisition
  • Desalination Plant and other above ground
    facilities
  • Based on 2009 communication with licensed real
    estate appraiser
  • Residential 400,000 - 1,000,000/Acre
  • Light Industrial 600,000 - 800,000/Acre
  • Agricultural 3,000 - 40,000/Acre
  • ROW Acquisition for Pipelines (Present Worth)
  • Transportation Agency of Monterey County and
    private agricultural lands evaluated by licensed
    real estate appraiser

20
Allowances
  • Electrical / IC
  • Contractor OHP
  • 18.5 except for RO Equipment at 10
  • Contractor Mobilization/Demobilization
  • Included in OHP. Added 1 for Desalination
    Plant only

21
Allowances (contd)
  • Implementation
  • Project Administration and Management,
    Engineering, Legal
  • Design/Bid/Build Facilities Used 30 of base
    construction costs, based on experience,
    excluding costs through December 31, 2008.
  • Design/Build Facility Used 20 of base
    construction costs
  • Contingency
  • Covers unanticipated changes in project scope or
    schedule due to unforeseen changed site
    conditions regulatory or institutional
    requirements, including mitigation implementation
    and permit compliance and acts of nature.
  • 20, based on AACEI, for conceptual design
    stage of project development.

21
22
North Marina Capital Cost Estimate Summary ( 2009
)
  • Off-site Feedwater/Brine 20M
  • Desalination Plant 81M
  • Desalinated Water Conveyance 38M
  • Terminal Reservoir/ ASRPS 15M
  • ASR System 10M
  • Subtotal for Construction 164M
  • Implementation Costs 42M
  • Present Worth of Land/ROW Costs 5M
  • Contingency Allowance 42M
  • Total Capital Costs 253M
  • Rounded to 250M

22
23
Accuracy of Estimate
  • Cost estimating accuracy is typically keyed to
    project development stage
  • North Marina Alternative between Class 3 and
    Class 4
  • AACEI Class 3-Budget, 10-40 -10/20 to 10/30
  • AACEI Class 4-Study, 1-15 -15/30 to 20/50
  • Used -15/25
  • Final North Marina Project capital costs could be
    in range of 210M to 310M in 2009 Dollars.

23
24
Operation Maintenance Costs
ML Moss Landing NM North Marina X Both
Sites OM Costs Avoided Include Energy,
Chemicals, Labor
25
Energy
  • Energy Rate Schedules were selected considering
  • Based on PGE Tariffs
  • Load
  • E-19 (lt 1000 kw)
  • E-20 (gt 1000 kw)
  • Grid Voltage
  • Transmission Voltage
  • Primary Voltage
  • Secondary Voltage

26
Energy (contd)
  • Unit Costs for Energy for each facility were
    developed considering
  • Time of day (Peak, Partial Peak, Off-Peak)
  • Season (Summer / Winter)
  • Service Voltage
  • Maximum Demand per Month
  • Average Use per month
  • Diurnal Load Profiles
  • Energy Unit Costs 0.079 - 0.142 /kWh
  • North Marina Desal Plant Unit Costs
  • Winter 0.093 / kwh
  • Summer 0.136 / kwh
  • Highest Unit Cost is at remote pump stations

27
Chemicals
  • Variable according to annual production
  • Chemicals and dosages per DEIR Project
    Description
  • Chemical costs obtained by 2009 quotation from
  • national vendor
  • Bulk delivery and storage

28
Labor
  • Fixed, does not vary with annual production
  • Operations labor categories and rates from CAW-
    Monterey
  • Desalination plant staffing levels estimated on
    basis of two other desalination plants and
    consultation with industry experts

29
Repair and Replacement
  • Assumed replacement of 15 of membranes every
    year starting in 2017 for North Marina Project
  • Assumed RR for structures, buildings, and civil
    works at 1 of original cost, per year.
  • Assumed RR for mechanical and electrical systems
    at 3 of original cost, per year.

30
OM Costs Avoided
  • Project will reduce production and operations
    costs at
  • Begonia WTP (BIRP) by 6,900 afy, 1.36M annual
    reduction
  • Segunda PS, by 6,900 afy, 0.37M annual reduction
  • Seaside Wells, by 2,200 afy, 0.28M annual
    reduction
  • Datum used is current conditions
  • Begonia WTP (BIRP) at 11,500 afy
  • Seaside Wells at 3,700 afy
  • Avoided costs were developed on basis of existing
    operational data, calculation of avoided power,
    and consistent (calculated) energy unit cost

31
North Marina ProjectOM Cost Estimate
  • For 2021, in 2009 Dollars, at 10,900 AFY
  • Desalination Plant 9.2M
  • Desalinated Water Conveyance 0.5M
  • ASR System 0.5M
  • Total (gross) 10.2M
  • Costs avoided ( 2.0M)
  • Total (net) 8.2M

31
32
  • End of Formal Presentation
