1
  • This presentation will probably involve audience
    discussion, which will create action items. Use
    PowerPoint to keep track of these action items
    during your presentation
  • In Slide Show, click on the right mouse button
  • Select Meeting Minder
  • Select the Action Items tab
  • Type in action items as they come up
  • Click OK to dismiss this box
  • This will automatically create an Action Item
    slide at the end of your presentation with your
    points entered.

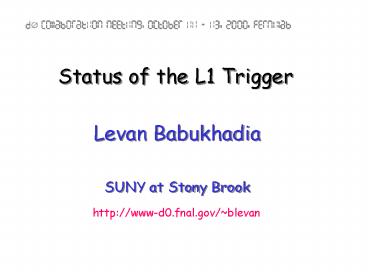

D? Collaboration Meeting, October 11 - 13, 2000,
Fermilab
Status of the L1 Trigger
Levan Babukhadia
SUNY at Stony Brook
http//www-d0.fnal.gov/blevan
2
CTPT/FPS Components
  • Analog (Fermilab - DØ)
  • AFE-8MCM (primarily CFTax)
  • 10 here, ready by 11/01, 54 more by 12/15,
    balance 01/30/01
  • Crates/Cables on hand, installed when required
  • Power supplies delayed until new year (partial).
  • Mixer ( Fermilab - CD )
  • Super-sector (1/5th) mid-November
  • Full Mixer 1/01
  • Digital ( Fermilab - DØ )
  • All MBs here and in testing
  • Transition boards expecting in 2 weeks
  • CTPT DBs (single-wide, 5 Virtex 2.5v FPGAs) by
    mid-November
  • FPS DBs (double-wide, 3 Virtex 2.5v FPGAs)
    partial order out
  • Xilinx/Virtex FPGAs for CTOT on order, others
    held until further decision, Virtex vs. Virtex-E
  • Crates/Cables/PS all here by mid-November

3
CTTP/FPS Firmware CFT/CPS Axial
  • DFEA (80) Jamieson Olsen (Kin is gone)
  • Both L1/L2 firmware in good shape
  • 4 FPGAs find tracks in 4 Pt and report to 5-th
    FPGA and to Muon
  • Backend (5-th) FPGA does CPS cluster finding and
    track matching
  • firmware has to be re-written, concerns on the
    chip size
  • expect functional and tested firmware in a couple
    of months
  • CTOC (8) Juan Lizarazo, now Ricardo Rodrigez
  • Both L1/L2 firmware completed and tested in
    testbench
  • Minor issues and additions will be addressed by
    Ricardo/Manuel
  • CTQD (4) Pavel Polozov now gone
  • L2CFT part completed functionally with some minor
    issue
  • Needs implementation, L2CPS, and all of this
    tested in the hardware
  • CTTT (1) Jerry Blazey
  • Algorithm/VHDL/Functional/Implementation at 20
  • 2 out of 64 Trigger Terms done through the
    implementation phase
  • L1-gtL3 sender, finish all VHDL, implementation,
    hardware test stand

4
CTTP/FPS Firmware CPS Stereo
  • DFES (5) Qichun Xu, MSU
  • No link to L1 TM, straight to L2 and L3, thus has
    time!
  • Main issue is cluster finding in the large number
    (500) of CPS stereo strips in a sector but
    having time may save the day...
  • New MSU student Qichun Xu, just started
  • Made a good head-start with an overall algorithms
    and the cluster finding algorithms in particular
  • Start writing VHDL, expect functional code in
    about 1-2 months
  • CPSS (2) ?!
  • Nobody yet! Perhaps Qichun will take on this one
    as well ...

5
CTTP/FPS Firmware FPS
  • DFEF (32) Levan Babukhadia
  • Challenge cluster finding in 144 FPS strips at
    the L1 rate
  • L1 U/V algo developed, coded, and implemented
    test stand is next
  • L1U and L1V each takes Xilinx/Virtex 400 FPGA
    (75, 63 MHz)
  • Develop L2 priority reporting algo to take care
    of truncation. It is aimed at the 3rd FPGA
  • Transferring clusters within a DB or find
    clusters anew?...
  • FPSS (4) Mrinmoy Bhattacharjee
  • L1 algo developed, coded, and implemented w/o the
    L3 sender
  • fits in one Xilinx/Virtex 400 FPGA (30, 66 MHz)
  • Develop L2 algorithm
  • FPTT (1) Satish Desai
  • L1 algo developed, coded, and implemented w/o the
    L3 sender
  • fits in one Xilinx/Virtex 400 FPGA (20, 64 MHz)
  • Complete all L1 functionally, test stand by the
    end of October

6
CTPT/FPS Installation/Commissioning
  • Assembling test stands for digital/VHDL testing
  • Hardware 2 PCs, MBs, 2 Data Pump Boards, PS,
    cables, CTPT/FPS DBs
  • 1 fully stuffed double-wide DB
  • 10 fully stuffed single-wide DBs
  • Personnel Jamieson Olsen, Brian Connolly (very
    short time), Ricardo Rodrigez, and a new
    part-time tech
  • Had 1 working test stand but recently moved to
    DAB3/NE will be made operational this week
  • Aiming at having 2 single board bench-tops and
    1 multi-board test stand (for a one sparse
    system test -- available now, Jamieson)
  • Installing cables/crates on platform
  • Crates/Cables installed in MCH

7
Luminosity Monitor Status
  • Components
  • Scintillator (48) complete
  • CAFÉ boards (175) on hand
  • Completing ADC (12) board layout, ordering parts
  • Vertex board, FPGA 75 complete, layout
    commencing
  • Procuring signal cables (60) soon
  • Crate/PS on hand
  • Installation/Commissioning
  • Installed scintillator (4/00)
  • Cabling awaits FPS, commissioning thereafter
  • Software/Firmware
  • Working on embedded software
  • Download currently underway
  • Database under development
  • Schedule (on time)
  • Electronics installed, February 1 Lum Monitoring
    March 1
  • And/Or terms, March-April

8
L1 Calorimeter Trigger Status
  • Timing signal generation and distribution
  • Some work has been done and some tests have been
    made
  • Initial implementation will probably cover just
    the CC racks
  • L2/L3 readout complete (by November)
  • Uses much of the same equipment as the readout
    from the TF
  • All circuit boards exist and initial designs of
    all the FPGAs exist
  • Analog input circuit (pick-off) boards (320)
  • Prototypes of this exist and some testing has
    been done
  • 1FTE month to production
  • Quadrant Terms
  • Circuit board (40) and FPGA design work has been
    started
  • No prototypes exist yet
  • Will not be pushed in the immediate future
  • Schedule (late but well before 3/01)
  • Inactive until TF complete 11/00. Resume within a
    month
  • Start with analog pick-offs

9
L1 Muon Trigger Status
  • L1MU Hardware (4 crates, prod beginning UAz)
  • Crate Manager (MTCM)
  • Production card testing in progress
  • Motherboard (MTCxx - Trigger Card)
  • Production cards beginning fabrication
  • Flavor Boards
  • Production Trigger Manager (MTM) boards ready for
    fabrication
  • Production wire DB (MTC10) design in progress
    (finish in 2 weeks)
  • Preproduction scintillator DB (MTC05) in
    fabrication
  • SLDBs (Gbit/s Serial Links)
  • Production board testing in progress
  • Software/Firmware
  • Download infrastructure in place
  • Preproduction versions of all firmware exist
  • No alarms, monitoring

10
L1 Muon Trigger Status
  • MCEN Hardware (5 crates, in preprod testing BU)
  • Crate Manager (MCCM)
  • Preproduction card layout in progress
  • Centroid Finder Cards (MCEN)
  • Preproduction card testing in progress
  • Physics Boards (MCPB)
  • Preproduction board testing in progress
  • Infrastructure
  • Custom VME backplanes completed
  • Power supplies
  • Prototype assembled and tested
  • VICOR supplies ordered but with 20-22 week lead
    time
  • Platform Services -- on hold pending final cable
    plant design
  • Cabling (1,600)
  • Production at Fermilab and NIU in progress

11
L1 Muon Trigger Status
  • Near Term Commissioning Goals
  • Mid-August
  • Stable operation of one (sparse) L1MU trigger
    crate and the L1MU MTM crate
  • still using preproduction cards
  • Early October
  • Add L1CTPT MTM crate to the above
  • Mid-October
  • Begin commissioning production of L1MU crates and
    cards
  • Longer Term Commissioning Goals
  • Begin full crate testing in late Dec or early Jan
  • Two octant triggering until then
  • MCEN cards 2 months behind above
  • Temporary power supplies for full crate tests

12
Trigger Framework Status
  • All equipment operational and installed
  • Defective SCL cables are being repaired
  • L3 readout
  • Finish up making readout to L3 available for
    normal use (by 1/11)
  • Master Clock synchronization with the Tevatron
    beam
  • This work now starting
  • Operational permit
  • Need to install 5 fuse blocks and write the
    documentation
  • L1 Specific Trigger Fired Mask to L2
  • Needed to make the Pseudo-Terms work
  • Deferred until some progress on getting L1 Cal
    Trigger running again
  • Firmware
  • Completion of pseudo-terms
  • Commissioning run-control
  • Personnel
  • Major loss of two engineers. Replacement uncertain
