MOUNTAIN VIEW POWER,INC Boise Planning - PowerPoint PPT Presentation

1 / 31
About This Presentation
Title:

MOUNTAIN VIEW POWER,INC Boise Planning

Description:

MOUNTAIN VIEW POWER,INC Boise Planning – PowerPoint PPT presentation

Number of Views:28
Avg rating:3.0/5.0
Slides: 32
Provided by: boblo8
Category:
Tags: inc | mountain | power | view | boise | com | dex | planning

less

Transcript and Presenter's Notes

Title: MOUNTAIN VIEW POWER,INC Boise Planning


1

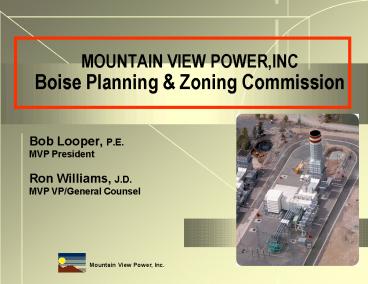

MOUNTAIN VIEW POWER,INC Boise Planning Zoning
Commission
  • Bob Looper, P.E.MVP PresidentRon Williams,
    J.D.MVP VP/General Counsel

2
MVP Proposal Summary
  • Build small, yet efficient and clean burning
    natural gas fired peaking power plants to be
    located in the East Boise - Gateway Industrial
    Park
  • Phase 1 A single 172 MW combustion turbine
    unit, fired during peak generation periods using
    clean burning natural gas
  • Phase 2 Up to 100 MW of Natural Gas Fired Power
    to facilitate additional Wind Generation
    facilities in Idaho

3
  • Treasure Valley Population
  • Growth Projections

4
Idaho Power Energy Surplus/Deficiency
5
Idaho Power Summer Peak Loads
6
Typical Summer Peak Day
7
Gateway Power Plant Phase I
8
Bennett Mt. 1

EAST BOISE GATEWAY POWER PLANT
9
Bennett Mt. 2
EAST BOISE GATEWAY POWER PLANT
10
Bennett Mt. 3
EAST BOISE GATEWAY POWER PLANT
11
Bennett Mt. 4

EAST BOISE GATEWAY POWER PLANT
12
Bennett Mt 5
EAST BOISE GATEWAY POWER PLANT
13
Gateway Industrial Park Siting Fundamentals
  • Gateway Industrial Park is well situated away
    from residential development and adjacent to I-84
    corridor, existing industry and Gowen Field
  • The Gateway Power Plant is located in the Boise
    load center adjacent to Boise Bench Substation,
    the largest station which serves the Treasure
    Valley
  • MVP Proposal is classified as a Minor Source for
    air emissions and requires permitting by IDEQ in
    compliance with EPA Air Quality Act. Dominant
    wind patterns from the West are away from
    population centers.

14
Gateway Power Plant Site North View
15
Gateway Power Plant Site North View
16
Gateway Power Plant Site South View
17
Gateway Power Plant Site Transmission
18
Gateway Power Plant Site - Looking South
19
Gateway Power Plant Site Looking North
20
Gateway Power Plant Site -- Attributes
  • Industrially zoned property on undeveloped land
  • Bennett Mtn. Plant as template with proven
    performanceLow Noise EmissionsLow Air
    EmissionsLow Visual Impact
  • Intermountain Gas 12 line within 2,000 feet of
    site
  • Idaho Power 230 kV transmission line on site
  • United Water 24 main water line within 2,000
    feet of site

Mountain View Power, Inc.
21
Gateway Power Plant Air/Noise Emissions
Mountain View Power, Inc.
  • Emissions from Gateway are less than existing
    surrounding uses at Gowen Field, Micron, I-84
    corridor
  • Noise emitted from Bennett Mtn. facility was 52
    dB at 400 ft. from plant
  • Emissions from Bennett Mtn. performed better than
    maximum requirements with 1 ppm Carbon Monoxide
    at full load, 20 ppm Nitrous Oxides

22
(No Transcript)
23
(No Transcript)
24
Pollution Estimates
25
GATEWAY SITE MVP Site Specifics
  • New lateral to Interconnect with United Water for
    fire and potable water supply
  • New lateral to City Sewer
  • New Gas lateral to existing 12 Intermountain Gas
    Pipeline
  • No pre-existing environmental/hazardous issues
    identified with Site Existing Conditions
  • Soil conditions will support conventional
    foundations
  • ACHD Requirements for road paving to Site Parcel
    from Eisenman Road

26
PHASE II - PROJECT FEATURES
  • Phase II to firm proposed wind generation in
    Idaho
  • Every 1 MW of wind capacity needs 1 MW of a
    firm generating resource behind it
  • A wind resource firmed with a gas fired peaking
    resource can defer the need for future generation
    such as coal fired plants

27
BASE PROJECT SCHEDULE
  • CUP Process 3 months
  • IDEQ Air Permit 6-12 months
  • Electrical Interconnection Study 6 months
  • Electrical Facility Study 4-6 months
  • Natural Gas Interconnection 12-18 months
  • Project Design Phase 6 months
  • Project Construction 12 months

28
PROJECT SUMMARY
  • Project will provide firm, reliable source of
    peaking power to meet future growth requirements
    for the Boise load center
  • Phase 1 Project completion possible within 18
    months of issuance of regulatory permits
  • Proposal represents the best available technology
    with the cleanest emissions in the region
  • MVP is a local company with a successful track
    record and current experience

29
PROJECT SUMMARY
  • Project Cost estimated at 75-100 million for
    Phase 1 and Phase 2
  • Project serves as anchor tenant for future
    development in the Gateway Industrial Park
  • Direct economic benefits to City of Boise include
    ground lease payments and property taxes.

30
Tons of Annual Emissions Near Gateway
31
Tons of Annual Emissions in Treasure Valley
