Transcript and Presenter's Notes

Title: HP3000 Lift and Shift Project


1

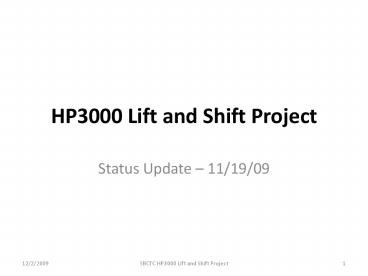

HP3000 Lift and Shift Project
  • Status Update 11/19/09

2
What is changing?
3
What is the HP3000 LnS Project Timeline
4
Current Project Status
  • Status Highlights
  • The Schedule for Project Technical Work is at 8
    complete.
  • First Speedware deliverable on schedule for end
    of December.
  • 1st QA Report published by Sterling Associates.
  • All Project Hardware and Software now purchased.
  • Dev/Test Environment installed and functional.
  • Detail Test Planning by SBCTC ITD continues.
  • Additional Unit Test Cases being developed by
    SBCTC ITD staff.
  • Weekly Status Meetings held with Speedware
    Project Management.
  • Production system being installed at DIS Data
    center in Olympia.
  • Project Technical Timeline is 18 months from
    September 21!

5
What we will be doing within the project?
  • Speedware, Inc. (Contractor) will be
  • providing replacement Software products to
    operate on the new HP-UX platform
  • migrating Student Management System, Financial
    Management System, and Payroll/Personnel System
    to operate with the new HP-UX platform and
    software
  • migrating DataExpress reporting to use an
    upgraded version of the software to minimize
    end-user training impact
  • mentoring SBCTC Information Technology Division
    staff in working with and supporting the new
    HP-UX hardware/software platform (knowledge
    transfer)
  • SBCTC ITD will be
  • - providing overall Project Management
  • establishing a new hosted production environment
    to consolidate all 34 colleges using the new
    HP-UX platform and software
  • supporting the contractor during technical
    migration activities
  • performing functional and system testing of the
    migrated Systems
  • converting remaining DataExpress reports for the
    colleges
  • learning how to technically support the new
    technologies
  • deploying colleges once migration and testing
    work is completed

6
What will be different in the systems after
project is completed?
  • End-user Impact
  • Project is not changing application system
    functionality
  • Project is not changing screens and reports,
    databases, forms
  • Project is not changing integration with
    external systems
  • College IT Impact
  • Project uses next generation computer
    technologies to replace 30 year old products
  • Project consolidates 34 HP based systems to
    operate in a single hosted environment at the
    State of Washington primary data center
  • Technical and user support for the production
    systems will be provided by SBCTC ITD staff

7
Will there be a need for user training for the
new systems, DataExpress replacement, etc?
User Training requirements are expected to be
very limited with this project since the Systems
are not changing. There may be some minor
technical changes in how the replacement for DX
operates that requires instructional updates to
users. We will know more once the first migrated
DX reports are available from the
Contractor. The contractor and SBCTC ITD staff
will be converting DX reports however, users
will be asked to run these reports to make sure
the conversion was successful.
8
What you should know about the code freeze?
  • Why is a Code Freeze necessary?
  • - The Project requires control of any/all changes
    to the 3,000,000 plus lines of Application code
    (a mix of Cobol and other coding approaches)
  • - The Contractor bid price for the project was
    based upon the line of migrated code and
    limitations on any changes to the codebase
    during the project
  • Any changes to the codebase will be costly to
    the State, will have major impact on the vendor
    and SBCTC staff testing the migrated systems
  • Code changes can cause major delay to the
    project completion
  • During the Code Freeze only Federally and State
    mandated changes or critical bug fixes to the
    Systems will be considered and these will tightly
    controlled
