Title: IE 2030 Lecture 5: Project Management Drawing Gantt Charts

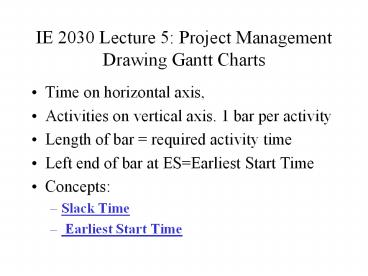

1IE 2030 Lecture 5 Project ManagementDrawing
Gantt Charts
- Time on horizontal axis,
- Activities on vertical axis. 1 bar per activity
- Length of bar required activity time
- Left end of bar at ESEarliest Start Time
- Concepts
- Slack Time
- Earliest Start Time
2IE 2030 Lecture 5 Gantt Charts
Slack time example
2
2
5
The first 2-time-unit activity has slack 0, and
the second has a slack of 1. Either (but not
both) could be delayed without delaying the
project
3IE 2030 Lecture 5 Gantt Charts
- Gantt Chart Pros and Cons
- Easy to understand, visual
- Can show how large a staff is needed
- Good for small projects
- Poor at showing precedence relations
- Poor at showing practical slack
- Doesnt deal with variability or uncertainty
4IE 2030 Lecture 5 PERT/CPM
- How to draw PERT/CPM networks
- Concepts Critical Path, Early Time, Late Time
- How to compute values. Why a good algorithmic
method is needed. - A model for dealing with uncertainty PERT, Beta
distribution, central limit theorem. Formulas
that make assumptions.
5IE 2030 Lecture 5 PERT/CPMHow to Draw Networks
- Each activity is represented by a unique arc
(branch) - Start node, Finish node
- Parallel arcs not permitted 2 arcs may not
share both head and tail nodes - Use dummy arcs as needed for precedence
- Nodes may be thought of as events such as the end
of an activity
69
B
C
8
4
A
F
12
10
2
D
E
7
Critical Path A,D,F. Early start time of D,F
Late time 12 Early start time of B,C 4 Late
start time5
710
B
C
8
4
A
F
12
10
3
D
E
7
Critical Paths A,D,F A,B,C,F A,D,E,F.
8Exponentially many paths
9Earliest Start Times -- Forward Computation
1
9
5
3
10
2
2
6
7
2
2
7
Algorithm to handle
Exponentially many paths
10Earliest Start Times -- Forward Computation Note
Early Finish Time Early Start Time Activity
Time
5
17
38
1
9
5
3
10
2
0
15
29
2
6
7
2
2
2
22
7
31
Algorithm to handle
Exponentially many paths
11Latest Finish Times -- Backward Computation Note
Late Start Time Late Finish Time - Activity
Time
5
26
38
1
9
5
3
10
2
0
15
29
39
2
6
7
2
2
9
22
7
37
Algorithm to handle
Exponentially many paths
Early S (F) Time Late S (F) Time for critical
path arcs
