Robust Portfolio Modeling for Scenario-Based Project Appraisal - PowerPoint PPT Presentation

About This Presentation
Title:

Robust Portfolio Modeling for Scenario-Based Project Appraisal

Description:

extention of stochastic dominance concepts to incomplete ... Use pair-wise stochastic dominance checks to obtain or. Helsinki University of Technology ... – PowerPoint PPT presentation

Number of Views:41
Avg rating:3.0/5.0
Slides: 21
Provided by: aht8
Category:

less

Transcript and Presenter's Notes

Title: Robust Portfolio Modeling for Scenario-Based Project Appraisal

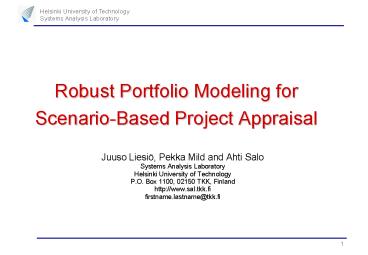

1
Robust Portfolio Modeling for Scenario-Based
Project Appraisal
  • Juuso Liesiö, Pekka Mild and Ahti Salo
  • Systems Analysis Laboratory
  • Helsinki University of Technology
  • P.O. Box 1100, 02150 TKK, Finland
  • http//www.sal.tkk.fi
  • firstname.lastname_at_tkk.fi

2
Project portfolio selection under uncertainty
  • Robust Portfolio Modeling in multi-attribute
    evaluation
  • A subset of projects to be selected subject to
    resource constraints
  • Projects evaluated with regard to several
    attributes
  • Allows for incomplete information about attribute
    weights and projects scores
  • Offers robust decision recommendations at project
    and portfolio level
  • Core Index values, decision rules
  • Use of RPM for project selection under
    uncertainty
  • Uncertainties captured through scenarios
  • Projects (single-attribute) outcomes known in
    each scenario
  • Incomplete information about scenario
    probabilities
  • Provides robust decision recommendations
  • Accounts for the DMs risk attitude, too

3
RPM with s cenarios (1/2)
  • Projects evaluated in each scenario
  • Projects ,
    outcomes
  • Scenario probabilities
  • Projects expected value
  • Portfolio is a subset of the available projects
  • Outcome of portfolio p in ith scenario
  • Expected portfolio value
  • A feasible portfolio satisfies a system of linear
    constraints

4
RPM with scenarios (2/2)
  • Problem for a risk neutral DM with known
    probabilities
  • Example n5 scenarios, m10 projects

5
Incomplete information on probabilities (1/2)
  • Incomplete information on probability estimates
  • Set of feasible probabilities
  • Convex polytope bounded by linear constraints
  • Several probability distributions consistent with
    this information
  • E.g. scenario 1 is the most likely out of three

6
Dominance concept for a risk neutral DM
  • Portfolio p dominates p if the expected value of
    p is greater than that of p for all feasible
    probabilities
  • Set of non-dominated portfolios
  • Multi-objective zero-one linear programming
    problem
  • MOZOLP algorithms Bitran (1977), Villareal and
    Karwan (1980), Deckro and Winkofsky (1983),
    Liesiö et al. (2005)

7
Identification of robust projects and portfolios
  • Core Index of projects
  • Share of non-dominated portfolios that include
    the project
  • CI(x)1 ? x is recommended
  • CI(x)0 ? x is not recommended
  • Examples of decision rules for portfolios
  • Maximin ND portfolio with the maximal minimum
    expected value
  • Minimax-regret ND portfolio for which the
    maximum expected value difference to other
    feasible portfolios is minimized

8
Consideration of risk
  • Accounting for risk aversion
  • The DM may be interested in portfolios that are
    dominated in the EV sense
  • We thus propose a less restrictive approach based
    on
  • extention of stochastic dominance concepts to
    incomplete probability information
  • introduction of constraints to rule out
    portfolios which do not satisfy risk
    requirements
  • Introduction of risk constraints
  • E.g., Value-at-Risk (VaR) The probability of a
    portfolio value less than must not exceed
    for any feasible probabilities

9
Additional dominance concepts (1/3)
  • Stochastic dominance
  • Probability of obtaining a portfolio value at
    most t
  • First degree
  • Second degree
  • Stochastic dominance checks computationally
    straightforward
  • Cumulative distributions are step-functions with
    steps
  • Check only required at the extreme points of
    feasible probability set

10
Additional dominance concepts (2/3)
  • Stochastically non-dominated portfolios
  • A feasible portfolio is non-dominated iff it is
    not dominated by any other feasible portfolio

11
Additional dominance concepts (3/3)
  • Properties
  • If then has a greater
    outcome in each scenario
  • Thus, for any set of feasible probabilities
  • Therefore
  • Computation of stochastically non-dominated
    portfolios
  • Solve the MOZOLP problem to obtain
  • Use pair-wise stochastic dominance checks to
    obtain or

12
Example (1/3)
  • Underlying precise probabilities
  • Approximated by incomplete probability
    information

13
Example (2/3)
  • Maximin , Minimax regret

14
Example (3/3)
  • Core Index values for projects
  • Risk neutrality may be too strong of an
    assumption
  • For risk averse DM recommendation can be based on
    SSD
  • Projects that can be surely recommended 1, 5 and
    8
  • Strong support for project 2 and lack of support
    for project 3
  • Decision rules for portfolios
  • Maximin projects 1, 2, 4, 5, 8, 10
  • Minimax-regret
  • FSD 1, 5, 7, 8, 9, 10
  • SSD 1, 2, 5, 6, 8, 10
  • Expected value 1,2, 4, 5, 8, 10

15
Conclusions
  • RPM for scenario-based project selection
  • Admits incomplete probability information
  • Computes all (stochastically) non-dominated
    portfolios
  • Indicates projects that are robust choices in
    view of incomplete information
  • Decision support
  • The DM is presented with several portfolios that
    perform well
  • Core Indexes support the comparison of projects
  • Decision rules assist in comparison of portfolios
  • Current research questions
  • Consideration of interval-valued multi-attribute
    project outcomes in scenarios
  • Explicit modeling of the DMs risk preferences

16
References
  • Liesiö, J., Mild, P., Salo, A., (2005).
    Preference Programming for Robust Portfolio
    Modelling and Project Selection, EJOR,
    (Conditionally Accepted).
  • Villareal, B., Karwan, M.H., (1981) Multicriteria
    Integer Programming A Hybrid Dynamic Programming
    Recursive Algorithm, Mathematical Programming,
    Vol. 21, pp. 204-223
  • Bitran, G.R., (1977). Linear Multiple Objective
    Programs with Zero-One Variables, Mathematical
    Programming, Vol. 13, pp. 121-139.
  • Decro, R.F., Winkofsky, E.P. (1983). Solving
    Zero-One Multiple Objective Programs through
    implicit enumeration, EJOR, Vol. 12, pp. 362-374

17
Several Time Periods
  • Model remains linear (cf. CPP)
  • Each project corresponds to several time-period
    specific decision variables
  • Future options depend on decisions in preceding
    periods
  • Linear constraints
  • Resource flow variables transfer leftover
    resources from one period to another
  • Maximization of expected value in the last period
  • Portfolios are compared through their performance
    in the last time period
  • LP model includes both continuos and binary
    variables
  • Multiple Objective Mixed Zero-One Programming
    (Mavrotas and Diakoulaki 1998)

18
Additional dominance concepts
  • First degree stochastic dominance
  • Sufficient and necessary condition
  • Stochastically non-dominated portfolios

19
How to model risk attitude? (2/3)
  • Computation of stochastically non-dominated
    portfolios
  • For any set of feasible probabilities
  • since
  • portfolio p
    has a greater value than p in each scenario
  • Algorithm
  • Solve the MOZOLP problem to obtain
  • Use pair-wise stochastic dominance checks to
    obtain

20
How to model risk attitude? (3/3)
  • Similar treatment for second degree stochastic
    dominance
  • Additional information on probabilities or DMs
    risk attitude narrows the set of good
    portfolios
  • For any set of feasible probabilities
