Planning Planet Project Controls Zone - PowerPoint PPT Presentation

1 / 28
About This Presentation
Title:

Planning Planet Project Controls Zone

Description:

Planning Planet Project Controls Zone A Roadmap to World Class Project Controls By Chris Carson, PSP, CCM, PMP Corporate Director of Project Controls, Alpha ... – PowerPoint PPT presentation

Number of Views:175
Avg rating:3.0/5.0
Slides: 29
Provided by: TomS170
Category:

less

Transcript and Presenter's Notes

Title: Planning Planet Project Controls Zone


1

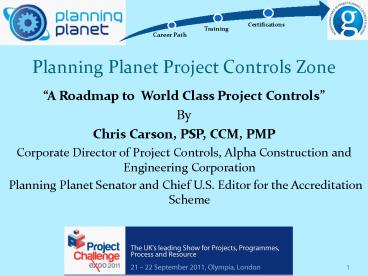

Planning Planet Project Controls Zone
  • A Roadmap to World Class Project Controls
  • By
  • Chris Carson, PSP, CCM, PMP
  • Corporate Director of Project Controls, Alpha
    Construction and Engineering Corporation
  • Planning Planet Senator and Chief U.S. Editor
    for the Accreditation Scheme

2
  • Chris Carson - Corporate Director of Project
    Controls, Alpha Corporation
  • Responsible for standards, processes, and
    procedures for a team of schedulers, analysts,
    and project controls managers in multiple
    locations, as well as analysis, work product, and
    testimony, marketing, and business development
  • Developed and manages the in-house project
    controls training program at Alpha
  • Certifications
  • PSP (Planning Scheduling Professional AACEi)
  • CCM (Certified Construction Manager - CMAA)
  • PMP (Project Management Professional PMI)
  • University University of Virginia, Mechanical
    Engineering, 1968 - 1972
  • Professional Field 38 years of experience in
    Construction Management Services specializing in
    Planning and Scheduling, Schedule Analysis,
    Estimating, Claims
  • Active in AACEi (Association for the Advancement
    of Cost Estimating International)
  • Author of Recommended Practices in Scheduling
    Forensic Schedule Analysis
  • Active in PMI (Project Management Institute)
    College of Scheduling
  • Vice President of Scheduling Excellence
  • Managing Director for SEI (Scheduling Excellence
    Initiative) writing Best Practices and Guidelines
    for Scheduling and Schedule Impact Analysis
  • Serving on team writing Best Practices for
    Scheduling for U.S. Department of GAO
  • Active in CMAA (Construction Management
    Association of America)
  • Served on committee revising Time Management
    Chapter of CMAAs CM Standards of Practice
  • Active in Planning Planet (global planning
    association)
  • Chief Editor for US, writing Planner Users
    Guide, developing accreditation Guild for planners

3
The Roadmap to World Class Project Controls
  • The key to successful projects is effective
    project controls
  • Effective project controls comes from a
    structured approach to developing the planning
    culture
  • Adoption of industry best practices
  • Recruiting, training, mentoring personnel
  • Maintaining state of the art competencies at all
    levels

4
The Roadmap to World Class Project Controls
  • There has been no well defined career path for
    project controls disciplines in the industry
  • Project controls cannot be easily learned on the
    job
  • Few companies offer training or mentoring
  • Nowhere is this more obvious than Forums, Groups,
    and Associations
  • Practitioners are crying out for help at all
    levels
  • International companies have recognized this
    industry shortcoming

5
  • Definition from Wikipedia
  • Project control begins early in the project with
    planning and ends late in the project with
    post-implementation review, having a thorough
    involvement of each step in the process. Each
    project should be assessed for the appropriate
    level of control needed too much control is too
    time consuming ( too costly in implementation),
    too little control is too costly (in results). If
    control is not implemented correctly, the cost to
    the business should be clarified in terms of
    errors, fixes, and additional audit fees.
  • Control systems are needed for cost, risk,
    quality, communication, time, change,
    procurement, and human resources.
  • All of these together make up project controls.
    Individually even the most proficient specialist
    will not be effective.

6
  • Project control is that element of a project that
    keeps it on-track, on-time, and within budget.
    (Wikipedia)
  • Project Control Needs (From Wikipedia)
  • Cost Estimating
  • Risk Management Schedule Cost
  • Quality Control
  • Communication Document Control
  • Time Control (Planning ) Scheduling
  • Change Management Schedule Cost
  • Procurement Schedule Cost
  • Human Resources Organization
  • Missing Needs
  • Forensic Analysis Claims Dispute Resolution

7
Importance of Project Controls in CM
  • Texas State Highway 130 Toll Road study, Asia
    Alvord, PMP, HDR Project Controls Manager
  • One of the largest sources of cost growth on
    construction projects is change orders.

8
Importance of Project Controls in CM
  • Steve Pinnell, PE, of Pinnell/Busch, Inc. 2004
    Survey
  • Risk Assessment and Best Practices in
    Scheduling
  • Major causes of changes (as surveyed by
    Contractors)
  • Scope changes average 39
  • Design errors average 25
  • Differing site conditions average 13
  • Owner delays and impacts average 9
  • Contractor estimate mistakes average 4
  • Contractor other errors average 5
  • Weather other average 5

9
Importance of Project Controls in CM
  • Risk Assessment and Best Practices in
    Scheduling
  • Owner /or project delays total 91 by
    Contractors
  • Scope changes average 39
  • Design errors average 25
  • Differing site conditions average 13
  • Owner delays and impacts average 9
  • Weather other average 5
  • Contractor responsible delay total 9 by
    Contractors
  • Contractor estimate mistakes average 4
  • Contractor other errors average 5

10
Importance of Project Controls in CM
  • Steve Pinnell, PE, of Pinnell/Busch, Inc. 2004
    Survey
  • Risk Assessment and Best Practices in
    Scheduling
  • Major causes of changes (as surveyed by Owners)
  • Scope changes average 32
  • Differing site conditions average 19
  • Design errors average 18
  • Contractor estimate mistakes average 12
  • Owner delays and impacts average 7
  • Contractor other errors average 6
  • Weather other average 6

11
Importance of Project Controls in CM
  • Risk Assessment and Best Practices in
    Scheduling
  • Owner /or project delays total 82 by Owners
  • Scope changes average 32
  • Design errors average 18
  • Differing site conditions average 19
  • Owner delays and impacts average 7
  • Weather other average 6
  • Contractor responsible delay total 18 by
    Owners
  • Contractor estimate mistakes average 12
  • Contractor other errors average 6

12
  • Contractors perceptions of Owner responsible
    change 91
  • Owners perceptions of Owner responsible change
    82
  • Less than 20 of the problems identified are the
    responsibility of the Contractor!
  • Changes must be identified, analyzed, and
    negotiated contemporaneously to provide
    appropriate time extensions to avoid claims
  • And, every project has change!

13
  • What does a World Class Project Controls effort
    look like?

14
Project Controls Oriented Corporate Culture
  • Planning monitoring are vital steps in process
  • Senior management must actively support culture
  • Culture requires
  • Development of project controls process
    integrating all disciplines
  • Planning and scheduling
  • Supported by cost estimating and budgets
  • Strong document control
  • Careful adherence to the contract
  • Claims avoidance
  • Speedy analysis and resolution of all issues
  • All project controls disciplines work together to
    identify, analyze, and resolve all issues
    affecting production or progress
  • Requires a serious commitment

15
Integration with Project Management
  • Project management team should be deeply involved
    with planning for proper buy-in
  • Project controls can provide useful analysis and
    recommendations
  • PM team uses results from project controls
  • PM team involves owner
  • Requires strong and repetitive interaction
    between project management and controls

16
The Planning Effort
  • Early master or planning schedule/programme
    developed
  • Integrated cost and schedule planning
  • Careful contract review
  • Constructability review for efficiency
  • Schedule/programme is designed to suit purpose
    components match needs
  • Hold formal schedule development/planning session
  • Includes project management team
  • Incorporates claims avoidance
  • Incorporates risk assessment into session

17
The Maintenance Effort
  • Provide effective process for maintenance/usage
    of schedule
  • Timely regular updates with short interim
    planning
  • Eliminate progress-only reporting power is in
    analysis
  • Formal process of schedule analysis feedback
  • Includes trending completion predictions
  • Includes claims avoidance risk review
  • Engage with continuous modeling of current means
    methods
  • Early identification of problems
  • Interactive implementation of any necessary
    course corrections
  • Formal change management process includes Time
    Impact Analysis
  • Resolve all time related issues contemporaneously

18
Industry Project Controls Associations Efforts
  • AACE international
  • True project controls association
  • Total Cost Management Framework with Recommended
    Practices supplying piecemeal bodies of knowledge
  • High level of quality, great products
  • Large amount of knowledge still to be captured

19
Industry Project Controls Associations Efforts
  • PMI College of Scheduling/Scheduling Community of
    Practice
  • Planning and scheduling only association
  • Time Management Chapter of the PMBOK contains
    some body of knowledge
  • Working on Best Practices and Guidelines for
    Scheduling, due out late this year
  • Future efforts BPG for Schedule Impact Analysis
  • PMI has several high-level Standards WBS,
    Scheduling, Earned Value

20
Industry CM Services Efforts
  • CMAA Construction Management Assoc. of America
  • Time Management Chapter
  • DBIA Design-Build Institute of America
  • CII Construction Industry Institute
  • Collaborated with CMAA now, produces Knowledge
    Structure
  • CIOB Chartered Institute of Building
  • Provides accreditation of courses
  • Published Guide to Good Practice in the
    Management of Time in Complex Construction
    Projects
  • RICS Royal Institution of Chartered Surveyors
  • Partial CM roles
  • Other specialty discipline associations such as
    cost estimating

21
Planning Planet Support for Guild
  • The International Guild of Project Planning
    Control and Delivery
  • Develop a body to enable recognition within PP
    community as well as employers/organizations
  • Align global industry variations in standards
    methods
  • Develop regional Centres of Excellence
  • Maintain a globally recognized suite of best
    practices
  • Support efforts of professional organisations
  • Supported by large body of professional
    organisations as sponsors

22
Planning Planet Support for Guild
  • Career Path
  • Focused by discipline
  • Contract Administration/Document Control
  • Cost Estimating
  • Planning and Scheduling
  • Forensic Analysis
  • Project Controls
  • Four or five levels of competence
  • Entry/Basic
  • Competent
  • Advanced
  • Specialty Manager or Expert
  • Industry Expert in Project Controls or Forensic
    Analysis

23
Planning Planet Career Paths
24
Planning Planet Career Paths
25
Planning Planet Support for Guild
  • Planners Users Guide - due out late this year
  • Planning Scheduling Best Practices Body of
    Knowledge
  • Other disciplines under development
  • Will provide the knowledge basis for
    certification
  • Level 0 Why Plan?
  • Level 1 Planning Methods
  • Level 2 Designing the Schedule/Programme/Project
    Plan
  • Level 3 Developing the Schedule/Programme/Projec
    t Plan
  • Level 4 Maintaining the Schedule/Programme/Proj.
    Plan
  • Level 5 Using the Schedule/Programme/Project
    Plan
  • Level 6 Forensic Analysis from a Scheduling
    Perspective

26
Planning Planet Support for Guild
  • The Accreditation Scheme
  • Will provide certification of achievement for
    steps along the career path
  • Will follow the best of the traditional flavor of
    a Guild or Trade Association
  • Clear requirements for knowledge and experience
  • Opportunity to work with mentors
  • Proof of achievement of the levels in various
    disciplines
  • Will be aligned with certifications by other
    organizations to help organize all relevant
    certifications

27
Planning Planet Support for Guild
  • Training for Best Practices
  • Will follow the Planners Users Guide and other
    guides
  • Training to be developed to facilitate
    progressive study to reach levels for each
    discipline
  • Training will include testing/feedback loop
  • Development will be online for ease of
    participation
  • Training will provide real-world skills that can
    be immediately implemented
  • Training materials to be developed by known
    experts in the various disciplines

28
Roadmap to World Class Project Controls
  • Planning Planet and the Guild are developing the
    first comprehensive package of career path
    guidance
  • Valuable for practitioners and employers
  • This is truly the roadmap to the world class
    projects controls weve all envisioned!
Write a Comment
User Comments (0)
About PowerShow.com
