Introduction to the WTO - PowerPoint PPT Presentation

1 / 17
About This Presentation
Title:

Introduction to the WTO

Description:

Federal & State Regulatory Issues Elizabeth W. Whittle Nixon Peabody LLP 401 9th Street, N.W. Washington, D.C. 20004 (202) 585-8338 ewhittle_at_nixonpeabody.com – PowerPoint PPT presentation

Number of Views:59
Avg rating:3.0/5.0
Slides: 18
Provided by: Amel86
Category:

less

Transcript and Presenter's Notes

Title: Introduction to the WTO

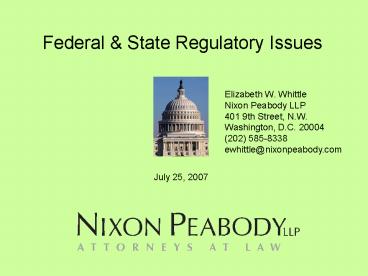

1
Federal State Regulatory Issues
Elizabeth W. WhittleNixon Peabody LLP401 9th
Street, N.W.Washington, D.C. 20004(202)
585-8338ewhittle_at_nixonpeabody.com


July 25, 2007
2
Federal and State Regulatory Issues
  • As a wholesale supplier of power, a wind
    developer will be subject to regulation under the
    Federal Power Act (FPA). The Federal Energy
    Regulatory Commission (FERC) administers the FPA.
    FERC has jurisdiction over both the transmission
    and the sale of this power.
  • Siting and related matters are subject to the
    jurisdiction of the states.

3
Transmission Regulatory Scheme
  • Transmission service is governed by utility
    tariffs. In many regions, transmission service
    is provided by an Independent System
    operator/regional transmission organization
    (RTO/ISO).
  • RTO/ISOs do not own the transmission assets, but
    have operational control over them.
  • Open-access, non-discriminatory transmission
    service is provided pursuant to a Tariff on file
    and approved by FERC.

4
Transmission Regulatory Scheme
  • Tariffs govern
  • Interconnection
  • Transmission
  • Ancillary service
  • Rates
  • Dispute resolution

5
Interconnection
  • The interconnection process has been
    standardized. Each Transmission Owner or RTO/ISO
    has tariff provisions governing the process from
    the filing of an interconnection request to the
    execution of the Interconnection Agreement.
  • While the process is standardized, there are
    limited regional differences that are permitted
    by FERC. Milstones must be met to remain in the
    interconnection queue.
  • The process includes a number of steps, many of
    which must be followed by deposits. Developer
    must pay for the costs of all studies.
  • Interconnection Request - 10,000
  • System Reliability Study - 50,000
  • Facility Study - 100,000
  • Interconnection Agreement - 250,000 if cant
    show evidence of site control

6
Sale of Power at Market-Based Rates
  • FERC authorization is required to sell power at
    market-based rates even if power is sold only
    into the RTO/ISO market.
  • In order to obtain authority to engage in sales
    for resale at market-based rates the Developer
    must show that
  • It lacks market power over generation
  • It lacks market power over transmission
  • Cannot erect other barriers to entry and
  • Neither it nor its affiliates engage in
    reciprocal deals or otherwise abuse an affiliate
    relationship.

7
Sale of Power at Market-Based Rates (Contd)
  • On June 21, 2007 FERC issued Order No. 697 (119
    FERC 61,295), which revises some of FERCs
    market-based rates rules.
  • The Final Rule is 643 pages long!
  • FERC examines vertical and horizontal market
    power.

8
Sale of Power at Market-Based Rates (Contd)
  • Horizontal Market Power If an entity passes the
    market screens established by the FERC, the
    entity is presumed to lack market power.
  • If an entity fails the market screens, the entity
    is presumed to possess market power and must
    rebut the presumption by performing the delivered
    price test.
  • The geographic market is usually either the
    sellers balancing authority area or the
    RTO/ISO footprint.

9
Sale of Power at Market-Based Rates (Contd)
  • Vertical Market Power FERC assumes that no
    market power exists if there is an open access
    transmission tariff on file.
  • FERC can revoke market-based rates and impose
    cost-based rates on the entity and, in some
    cases, the entitys affiliates.

10
Ongoing Obligations Market-Based Rates
  • Once a seller obtains market based rate
    authority, there are reporting obligations.
  • Each quarter, the seller must report to FERC
    electronically details of its activities,
    including Mwh sold, aggregate prices, etc. Even
    if there is no activity, the report must be
    filed.

11
Market Power Updates
  • Category 1 Sellers (those marketers which own or
    control 500MW or less and not affiliated with a
    public utility with a franchised service
    territory) do not have to file market power
    updates periodically.
  • Category 2 Sellers (those who are not Category 1)
    must file updates to show that they continue to
    qualify. FERC establishes a filing schedule for
    the periodic updates.
  • All sellers must file changes in circumstances
    with the FERC.

12
Qualifying Facility/Exempt Wholesale Generator
  • Wind projects are qualifying small power
    production facilities.
  • The Public Utility Regulatory Policies Act of
    1978 (PURPA) required among other things the
    utility, if requested, to purchase all of the
    output (net) of QFs at the utilitys avoided
    cost.
  • Also, under PURPA, the FERC was given the
    authority to exempt QFs from provisions of the
    FPA, including rate regulation under Section 205.
  • On August 8, 2005, Congress enacted the Energy
    Policy Act of 2005 (EPAct) which among other
    things gave FERC the authority to allow the
    utility to escape from the mandatory purchase
    obligation if QF has non-discriminatory access to
    three markets defined in the legislation.

13
Qualifying Facility/Exempt Wholesale Generator
(Contd)
  • FERC implemented EPAct and issued Order No 688,
    (71 FR64342 (2006), Order on rehg, 119 FERC
    61,305 (2007), which established guidelines for
    utilities to escape from the mandatory purchase
    obligation. FERC created three rebuttable
    presumptions.
  • For projects with a capacity over 20MW, in Day
    2 RTO/ISO markets, there is a rebuttable
    presumption that those markets are workably
    competitive. The 4 Day 2 markets are Midwest
    ISO, New York ISO, PJM and ISO-New England.

14
Qualifying Facility/Exempt Wholesale Generator
(Contd)
  • For projects with a capacity over 20MW, QFs
    located in markets where service is provided
    under an open access transmission tariff are
    presumed to have non-discriminatory access to
    markets in that transmission providers
    territory.
  • QFs with a net capacity 20MW or less are presumed
    to not have non-discriminatory access to any
    markets.

15
Qualifying Facility/Exempt Wholesale Generator
(Contd)
  • As a result of these presumptions, many QFs with
    a net capacity of greater than 20MW will no
    longer have local utility as an involuntary
    purchaser of power. That doesnt mean that the
    utility wont voluntarily purchase the power at
    an agreed upon or auction-based price.
  • If a project does not avail itself of the
    benefits of QF status, developers obtain Exempt
    Wholesale Generator (EWG) Status. EWGs are
    exempt from certain regulations under the Public
    Utility Holding Company Act of 2005.

16
Qualifying Facility/Exempt Wholesale Generator
(Contd)
  • In EPAct, the Congress repealed the Public
    Utility Holding Company Act of 1935, eliminating
    the onerous SEC-related reporting requirements
    that fell on public utility holding companies.
  • While the exemption from regulations as an EWG
    may not seem as valuable, it is important to
    maintain EWG status in order to claim certain
    exemptions from filing, e.g., to dispose of a
    facility under FPA Section 203. (See FERC Order
    No. 669).
  • Once EWG status is obtained, material changes in
    circumstances -- changes in upstream ownership,
    etc. must be reported to FERC.

17
State-Related Issues
  • Many wind development requirements are under
    State jurisdiction. Unlike natural gas pipelines
    where FERC has siting jurisdiction, siting
    matters are left to the State.
  • Each State has it own siting schemes. Most
    require an approval/certificate from the Public
    Utility Commission (PUC) that the project is in
    the public convenience and necessity.
  • Often this review entails an environmental
    assessment or related environmental document and
    the involvement of state environmental agencies.
  • Many environmental studies are often required - -
    noise, bats, birds, impacts on landowners, etc.
  • Counties and towns also have authority under
    local zoning laws.

18
State-Related Issues (Contd)
  • States may be the administrator of renewable
    energy credit/RPS standards.
  • Many states also regulate the utility as a public
    utility, although each may have lightened
    regulation or a way to obtain exemptions from
    state commission jurisdiction.
  • In New York, for example, developers file an
    application for lightened regulation.
