Transition Update Briefing - PowerPoint PPT Presentation

1 / 18
About This Presentation
Title:

Transition Update Briefing

Description:

MySQL database with 55 tables has been transitioned. Real-time Data Monitoring Subsystem ... Re-hosting legacy software code is ongoing. ... – PowerPoint PPT presentation

Number of Views:38
Avg rating:3.0/5.0
Slides: 19
Provided by: Kev57
Category:

less

Transcript and Presenter's Notes

Title: Transition Update Briefing

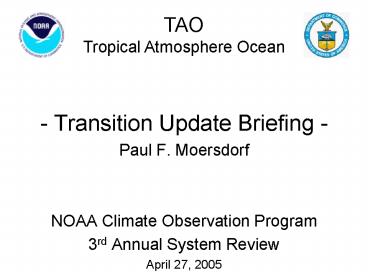

1

TAO Tropical Atmosphere Ocean
  • - Transition Update Briefing -
  • Paul F. Moersdorf
  • NOAA Climate Observation Program
  • 3rd Annual System Review
  • April 27, 2005

2
Outline
  • Transition Goals
  • Phased Transition
  • Schedule
  • FY2005 Activities
  • Software Transition
  • Approach Schedule Status Issues / Risks
  • Transition Metrics
  • Summary
  • Backup Slides Activities by Fiscal Year

New
New
New
New
3

Transition Goals
  • Community understanding of Transition Plan.
  • Activities transparent to both research and
  • operational users, both domestic and
    international.
  • Track metrics developed from operational and
  • research requirements.
  • Establish and maintain successful NWS / OAR
  • partnership enabling transfers from research
    to
  • operations.

4

Phased Transition
  • NDBC assumed management responsibility on
    October 1, 2004.
  • Technical interface team will be at PMEL and
    NDBC as appropriate during the transition
    process.
  • The tropical mooring data assembly center (DAC)
    will be established at NDBC.
  • PMEL will be funded to conduct FY2005
    operations.
  • Configuration change process allows for new
    requirements subject to NOAA approval process.
  • Acquire new resources (FY06 CCRI Tropical Buoy
    Expansion FY07 Program Plan) to capitalize on
    tech development of the next generation of moored
    buoys.

Climate Change Research Initiative
5
Schedule
6
FY2005 Activities
7
Software TransitionApproach
  • TAO consist of five subsystems, as identified
    below
  • Real-time Processing Subsystem
  • Inventory Calibration Subsystem ()
  • Real-time Data Monitoring Subsystem
  • Delayed-Mode RAM Processing Subsystem
  • Web Data Display and Delivery Subsystem
  • The TAO transition is primarily a re-hosting
    effort from Solaris at PMEL to Linux at NDBC.
    Otherwise, all software and data storage
    processes will remain the same.
  • Due to the phased transition, there will be
    shared responsibility for the Inventory and
    Calibration Subsystem through FY06 when NDBC
    transitions the Engineering / Operational portion
    of TAO

8
Software TransitionSchedule
  • Completed items
  • Kickoff meeting between NDBC/PMEL October 2004
  • Initial Requirements Meeting January 2005
  • Receiving TAO ARGOS data at NDBC January 2005
  • Software Requirements Specification February 2005
  • Architecture Document February 2005
  • Installation of two servers at NDBC March 2005
  • End to End Testing Apr-Jun 2005
  • Initial Operational Capability June 2005
  • Full Operational Capability July 2005

9
Software TransitionStatus
  • Real-time Processing Subsystem
  • 29 programs and 42 scripts/Perl modules have been
    compiled and are being tested. MySQL database
    with 55 tables has been transitioned.
  • Real-time Data Monitoring Subsystem
  • 82 scripts (Shell, Perl, CGI) have been modified
    and ready to test.
  • Web Data Display and Delivery Subsystem
  • 1,523 programs have been compiled 239 scripts
    (CGI, Java) have been modified approximately
    3,000 modules are outstanding.
  • Delayed Mode Subsystem
  • All 560 software modules are outstanding.

10
Software TransitionIssues / Risks
  • Much legacy software.
  • Porting code versus a development effort requires
    more coordination upfront but less time for
    parallel testing.
  • Requires PMEL support throughout migration.
  • QA process is highly interactive.
  • Present NDBC contract expires at critical time in
    schedule.

11
Transition Metrics
12

Summary
  • Transition is proceeding.
  • Re-hosting legacy software code is ongoing.
  • Lack of OAR transition funding for PMEL is
    slowing transition.
  • Tsunami efforts utilize some of the same folks.
  • Availability of FY2006/2007 funding is needed for
    technology refresh.
  • Timing of PIRATA transition undecided.

13

TAO Tropical Atmosphere Ocean
  • Backup Slides
  • Activities by Fiscal Year

14
FY04 ActivitiesPhase 0
  • 1. TAO data used to detect and forecast 2004 El
    Nino
  • 2. Transition Plan given to Climate Program
    Manager.
  • 3. Internal and external groups reviewed plan.
  • 4. Tropical portion of CCRI defined during
    PPBES06.
  • 5. Climate Program addressed pre-planned
    product
  • improvement in PPBES07.
  • 6. PMEL / NDBC partnership learned valuable
    lessons
  • in DART transfer.
  • 7. NDBC / PMEL have provided Office of Global
  • Programs with data management support.

15
FY05 ActivitiesPhase I
  • 1. Maintain the existing TAO data availability.
  • 2. Establish a tropical mooring data assembly
    center
  • (tropical DAC) at NDBC.
  • 3. Establish NDBC / PMEL TAO Transition Team in
  • Seattle.
  • 4. Provide Technology Refreshment Plan to
    Climate
  • Program for approval.
  • 5. Ensure TAO assets (i.e., buoys and ship
    resources)
  • are available for use in research
    activities.
  • 6. Provide next generation mooring proposal to
  • Climate Program for approval.

16
FY06 ActivitiesPhase II
  • 1. Maintain the TAO data availability.
  • 2. Maintain DAC to support both researchers
  • and operational users.
  • 3. Continue to refresh obsolete TAO array
    components in accordance with the approved
    Technology Refreshment Plan.
  • Fund technology development of next
  • generation tropical mooring design.
  • 5. Prepare PIRATA transition plan.

17
FY07 ActivitiesPhase III
  • 1.  Maintain TAO array at present availability.
  • 2.  Merge DAC with NDBC IOOS DAC.
  • 3.  Complete procurement of tech refresh
  • components.
  • Fund Pre-Planned Product Improvements
  • based on the next generation tropical
    mooring developments in response to operational
    gap.
  • 5. Conduct final review of transition.

18

TAO Tropical Atmosphere Ocean
  • Contact Information
  • Paul F. Moersdorf, PhD
  • Director
  • National Data Buoy Center
  • Stennis Space Center, MS 39529
  • paul.moersdorf_at_noaa.gov
  • 228-688-2805
