Title: Mercy Medical Center

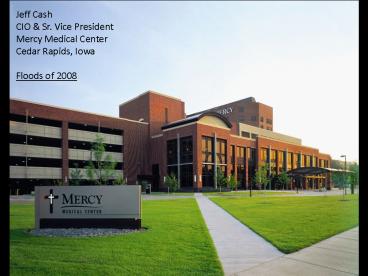

1Jeff Cash CIO Sr. Vice President Mercy Medical
Center Cedar Rapids, Iowa Floods of 2008
2Mercy Medical Center Cedar RapidsGeneral
Information
- Sisters of Mercy Hospital Established in 1900
- Licensed for 450 Beds
- Supported by approximately 370 Community
Physicians - Associated MPS Primary Care Network
- 20 Sites, Approximately 90 Providers
- Most Wired Winner in 2006 and 2008
3Mercy Hospital 2008 Flood
4Mercy Flood Video
5Timeline and Course of Action
- Monday June 2nd
- CIO Leaves for 3 week family vacation in Europe.
- 10 Days before the flood..
6Thursday, June 12th Paris France(No Flooding
in Paris)
7Thursday, June 12th Cedar Rapids, MMC (Flooding
in Cedar Rapids)
81st Rule of Disaster Planning
- Prepare in Advance - Not During the Disaster
- You dont know who will be there when disaster
strikes - Approximately 140 Mercy Employees Directly
Affected - In our case, we had excellent leadership in place
9Downtown Cedar Rapids Normal View
10Downtown Cedar Rapids Flood View
11Downtown Flood Zone Map With Mercy
12Cedar River Water Levels 2008 Flood
- 2008 Flood Crest 32 Feet
- Previous Flood Crest - 24 Feet
- Flood Stage 12 Feet
- Normal Depth 6 Feet
13Mitigation Efforts
- Sandbagging the facility was an all hands event!
- Hospital Staff
- Community Volunteers
- Vendors
- Hundreds of People with One Goal
14(No Transcript)
15(No Transcript)
16(No Transcript)
17What Happened Cause of Evacuation
- Water Sources
- Flood Waters Surround Hospital Depth up to 5
feet outside the facility, water breeches
sandbags and enters facility - Ground Water Pressure water pressure pushes
water in through floor and side walls of
foundation. - Black Water enters through sewer system plumbing.
- Service Outages
- Loss of electrical power and steam from local
utility - Water nears internal electrical distribution
systems - Primary Concern Potential loss of full
electrical power - Evacuation Coordinated with State EOC
- 176 Patients Evacuated
- All incoming patients diverted
18(No Transcript)
19(No Transcript)
20(No Transcript)
21Mercy Emergency Operations Center
- Utilized EOC structure from previous training
drills. -
- Reorganized leadership structure as necessary
- Established communications with external
organizations - Coordinated regular briefings for internal staff
- Maintained on-going event and work assignment log
22How Decisions Were Made
- Disaster Management Organization is key
- Disaster drills helped prepare our organizational
capabilities - Every Disaster is Unique
- They dont happen by the book
- Normal Job roles did not apply
- Re-organized to meet the situation not the
traditional roles. - Decisions will sometimes need to happen fast and
furious. - Centralized oversight (EOC), with localized
decisions
23(No Transcript)
24(No Transcript)
25(No Transcript)
26(No Transcript)
27(No Transcript)
28(No Transcript)
29Organizational Recovery Goals
- Recovery Timeframes
- Disaster Recovery Teams On-Site in 48 hours
- Re-open Cancer Services 72 Hours
- Fully Restore Services 2 weeks
- Fully Restore Facility 120 Days
- Organizational Commitments
- All employees will remain employed
- Rebuild will be Better than Ever
30(No Transcript)
31 Actual Timeline
1 Day
1 Day
2 Days
2 Weeks
3 Months
32Cleanup Begins
- Time is of essence
- Engage professionals with access to resources
- Work with regulatory agencies
- Invited in Department of Inspections
- Ordered long lead items immediately
- Construction Supplies and Equipment
- Work with staff to fill unconventional roles
33(No Transcript)
34(No Transcript)
35(No Transcript)
36Parking Ramp Salvaged Supplies
37(No Transcript)
38Parking Ramp Cleaning Chambers
39(No Transcript)
40(No Transcript)
41Recovery Efforts
- Temporary steam boiler arrives and is installed
- Mobile services arrive
- Cath Lab
- CT
- MRI
- Nuclear Medicine
42(No Transcript)
43(No Transcript)
44(No Transcript)
45Recovery Efforts
- Architects, Vendors, Engineers, and Hospital
Staff - Order construction materials and replacement
equipment - Organize the demolition and rebuilding efforts
- All ground floor and basement services relocated
- Clinical Services
- Emergency Department, Radiology, Physician
Offices, Therapies, Cardio Pulmonary, Treatment
Center - Support Services
- Lab, Pharmacy, Registration, Central Stores,
Central Sterile, Maintenance, Environmental
Services
46(No Transcript)
47(No Transcript)
48Flood of 2008Fun Facts
Click to edit Master title style
- Rebuild
- 22 Electricians averaging over 300 hours overtime
weekly - Replaced over 800 outlets and 150 lights
- 88 Carpenters working 1500 hours overtime weekly
- Installed 2,400 lineal feet of cabinets and
countertops - 2,500 sheets of Sheetrock (80,000 Square Feet)
- 250 five-gallon buckets of drywall compound
(1,250 Gallons) - 500 dumpsters taken to the landfill (20,000 cubic
yards) - Ran Generators for 355 hours, burned 15,000
gallons of fuel
- Click to edit Master text styles
- Second level
- Third level
- Fourth level
- Fifth level
49Flood of 2008Fun Facts
Click to edit Master title style
- Wall Coverings
- 2,000 yards of wallpaper
- 150 gallons of glue
- 550 gallons of paint
- Floor Coverings
- 9,000 sq. ft. ceramic tile
- 3,000 yards of carpeting
- 24,000 sq. ft. vinyl tile floor
- 2,000 sq. yards of vinyl sheet flooring
- 8,000 sq. ft. vinyl wood plank floors
- Over 4 miles of vinyl base installed
- Click to edit Master text styles
- Second level
- Third level
- Fourth level
- Fifth level
50(No Transcript)
51Rebuild
52Rebuild
53Rebuild
54Rebuild
55Data Center Services TimelineShutdown Due to
Power Concerns
- Friday June 13th
- Early Morning
- Relocated Backup Data Center to Primary Data
Center - Morning
- Contacted Qwest and had DMARC relocated
- Began shutdown of all non-essential I.T. systems
- Reroute key phones to Mercy Hospice
- Migrated web site and Physician Portal to
off-site hosted locations - Evening
- Finalized shutdown of all IT systems
- Data Network, Phones, Vocera, Internet are the
exception
56Data Center Services Timeline Startup
- Saturday June 14th
- Direct Generator Electrical Line to Primary Data
Center - Begin making plans to restore full IT operations
and Hospital operations - Sunday June 15th
- IS Systems Startup Begins
- Monday June 16th
- IS Systems Fully Operational
- 1st Patients Return to Cancer Center
57Information Services - What Worked Well
- Our Employees!
- Vendor Relationships!
- Vital, Cisco, HP, PEC, Qwest, Patient Keeper,
Vocera, Geonetric. - Technologies Deployed
- VoIP Network (Cisco)
- Data Network (Cisco)
- Vocera
- In-Building Cellular
- Citrix
- HP Storage and Server Blades
- VM Ware
- PolyServe
58Disaster Recovery (DR) Plan
- Business Continuity Planning
- Helped us focus on architecture and process for
disaster recovery - Know your Systems
- Know your Customers
- Know your Priorities
- Know your Vendors
- Critical System Redundancy
- Protect critical systems with redundancy
- Primary and Backup Data Centers
- Multiple Communications Systems voice and data
- Off-Site hosting where necessary Web Site and
EMR
59DR Systems In-Place
- Network
- Full fiber network redundancy between data
centers and floors - Wireless, LAN Switches and In-Building Cellular
on Generator Power - Dual Clustered Core Cisco Network Switches
- Dual Clustered Vocera Servers
- Note Vocera mobile communications support during
staff displacement - Dual Clustered Cisco Call Manager VoIP Telephony
Servers - Note Call Manger Device Support during
Department Relocations - Application
- Dual HP EVA SANs Utilizing Business Copy for
Data Redundancy - PolyServe for SQL Database and File Services
Redundancy - Dual Meditech HIS Platforms
60Lessons Learned What Worked Well
- Advanced planning and emergency response drills
are essential - Keep it Simple
- When trying to minimize impact, make changes that
are simple. - Dont hesitate to make decisions
- Mistakes will be made, learn from them and focus
on the big picture - Leadership structures in place
- Ask for HELP Partner with Experts.
- EXTRODINARY things happen when the entire
organization is focused on one goal!
61Next Steps and Opportunities
- Internal Organization Review of Disaster Response
- All Hands Meetings for What Worked Well and What
Didnt - Future Flood Mitigation
- Earth berm landscaping around facility for water
barrier - Sewer system disconnect
- Electrical distribution systems additional
water protection
62Questions and Answers
