Title: Rompre avec le pass

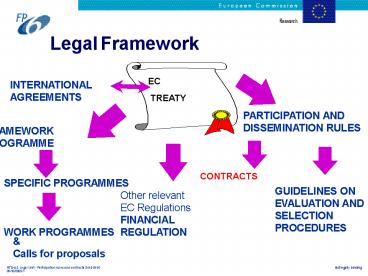

1 Legal Framework
EC TREATY
INTERNATIONAL AGREEMENTS
PARTICIPATION AND DISSEMINATION RULES
FRAMEWORK PROGRAMME
CONTRACTS
SPECIFIC PROGRAMMES
GUIDELINES ON EVALUATION AND SELECTION
PROCEDURES
Other relevant EC Regulations FINANCIAL
REGULATION
WORK PROGRAMMES
Calls for proposals
2Guidelines
- Will provide supplementary information and
guidance notes - Financial guidelines
- Negotiation guidelines
- Consortium agreement guidelines
- Project management guidelines
3General Principles
- Reflect requirements of the Legal Framework
- Simplification
- No different categories of contractors
- Reduction of the number of contracts
- Collective approach
- Greater flexibility
- the Work Programme may adjust Rules
- flexibility in the composition and changes to
consortium - Greater autonomy for participants
4The instruments
- RULES APPLIES TO ALL
- Integrated Projects new
- Networks of excellence new
- Specific targeted research or innovation projects
- Specific research projects for SMEs
- Co-operative research projects
- Collective research projects new
- Integrated infrastructure initiatives new
- Actions to promote human resources and mobility
(Some are new) - Co-ordination actions
- Specific support actions
- Article 169 new (specific rules to this
instruments)
5Contract Structure
- Core contract (standard with specifics of
project) - Annex I (technical tasks - the project)
- Annex II General Conditions
- (applicable to every instrument)
- Annex III Instrument specific provisions
(specific to instrument)
6Contract Structure
- Annex IV - Form A
- Consent of contractors identified in the
core-contract (article 1.2) to accede to the
contract. To be signed by the contractor
concerned and by the coordinator. - Annex V - Form B
- Accession of new legal entities to the contract.
To be signed by the new contractor concerned
and by the coordinator - Annex VI - Form C
- Financial statement per activity. Specific to
each Instrument and/or type of action. To be
filled periodically by each contractor
7Participation
- New Every legal entity that contributes to the
project (incl. Project Managers) - General Rule Participant contractor
- Every legal entity contributing to a project
must have a contractual link with the Community - Exceptional cases subject to very restrictive
rules - Third parties identified in Annex I
- Subcontractors
-
8Participation
- Third parties identified in Annex I
- In most of the cases they do not participate,
they simply make their resources available to a
contractor, this is not a case of participation
but only a question of eligibility of the cost
of these resources - In exceptional cases participation of
members of entities such as EEIG,UMR, SMEs
Associations - these entities are contractors (EEIG, UMR)
- their members can do some of the work on the
project even though they are third parties - contractor and third parties must have a previous
agreement, normally the constitution - the third parties, the agreement and the tasks
must be identified in Annex I
9Participation
- Subcontracting
- Contractors shall ensure that the work to be
performed can be carried out by them. - Exception where it is necessary to subcontract
certain elements of the work, this should be
clearly identified in Annex I. - Minor services may be subcontracted
- which do not represent core elements of the
project - which cannot be directly assumed by contractors
- where necessary for the performance of the project
10Signature and entry into force
- Contractual link of all contractors with the
Commission - New Contract enters into force upon signature
of coordinator and Commission - All the contractors are identified in the core
contract Art. 1.2 - Coordinator must ensure other contractors sign
within delays - Distribution of advance - Several options
available minimum number of participants/all
participants - Evolution of consortium possible
- where one or more does not sign the Form A
article 2 - in case of enlargement (new contractors)
article 3 - Project begins in the date established in the
contract (this can be before the contract enters
into force but usually later)
11Amendments
- Art.10 of Core Contract Art.8 of Annex II
- Request in writing
- New at the request of the coordinator, deemed to
act on behalf of the consortium - New Tacit amendments with implicit agreement of
the Commission within 6 weeks only for
modification and evolution of the consortium and
for technical reports - New in IP/NoE, enlargement of the consortium to
new contractors and new activities may be
foreseen. This enlargement follows a competitive
call launched by the consortium with evaluation
of proposals by external experts
12Financing what ?
- Community Financial Contribution
- (Arts 5 and II.24)
- Based on activities Articles II.2 and II.25
- Based on costs Articles II.19, II.20 and II.21
- Based on costs reporting models Art II.22
- Confirmed by an audit certificate Art II.26
13Financing
Grant for integration
Grant to the budget
Flat-rate
Networks of excellence ? Integrated Projects
? Specific targeted research projects
? Specific research projects for
SMEs ? Integrated initiatives relating to
infrastructure ? Actions to promote human
resources mobility ? ? Coordination actions
? Specific support actions ? ?
14Financing
Type of activity (a) Research and technological
development (including innovation related
activity) Demonstration Training Other specific
support activities New Consortium Management
costs reimbursed up to 100 within the limit of
7 of Community contribution (AC contractors
apply FCF)
15Financing
Type of activity (b)
16Financing
- Costs
- New principles
- 1 - cost categories are replaced by conformity to
contractors own accounting rules and legal
environment - 2 - simplify the eligibility criteria
- 3 - focus resources on the reality and the
necessity of the cost, rather than on formality
(cost categories) - Therefore, costs must be
- actual, economic and necessary for the project
- incurred during the duration of the project
(exception costs of the final reports) - recorded in the accounts (or third parties)
- and must exclude indirect taxes, duties,
interests, costs reimbursed in respect of another
Community project, and not give rise to profit
17Financing
- Cost Reporting Models
- FC actual direct and indirect costs (not
available for Coordination Actions and Specific
Support Actions) - New FCF (variant of FC) actual direct costs
flat rate for indirect costs (20 of total actual
direct costs, except costs of subcontracts - all
instruments) - AC actual additional direct costs flat rate
for indirect costs (20 of total actual
additional direct costs, except costs of
subcontracts - all instruments)
18Financing
- SMEs, non- commercial or non-profit
organisations established either under public or
private law, international organisations FC/FCF - Physical persons AC mandatory
- Private companies (other than above) FC
- AC only for those non- commercial or non-profit
organisations established either under public or
private law or international organisations that
do not have an accounting system that allows the
share of their direct and indirect costs relating
to the project to be distinguished. - General Rule a legal entity applies the same
cost model in ALL contracts established under FP6
except may move from AC to FCF/FC or from FCF to
FC (one way ticket)
19Financing
- Costs under FC/FCF
- Direct costs must be eligible costs that can be
related directly to the project - Indirect costs must be
- for FC eligible costs determined by the
contractor, in accordance with its usual
accounting practices and the definition of
indirect costs article II.21 - for FCF a flat rate is applied to the direct
costs to cover indirect costs.
20Financing
- Costs under AC
- Direct additional costs must be direct costs
additional to the normal recurring costs of the
contractor and not covered by any other sources
of funding.Three possibilities of charging costs
related to personnel - personnel with a temporary contract to complete a
doctorate - personnel with a temporary contract for working
under the Community contract concerned - personnel whose employment contract depends full
or in part on additional external financing. - Indirect costs consist of a flat rate applied to
the direct costs.
21Financing
- Receipts
- Three kinds of receipts must be taken into
consideration in order to avoid any possibility
of profit - Financial transfers or their equivalent to the
contractor from third parties - Contributions in kind from third parties
- Income generated by the project.
- In the first two cases (financial transfers or
contributions in kind), these endowments are
considered as receipts of the project if the
third party has provided them specifically to be
used in the project. - If, on the other hand, these endowments are at
the discretion of the contractor they are not to
be considered as receipts.
22Financing
- Receipts
- In the first two cases, where contributions from
third parties are used for the project by the
contractor, the latter is required to inform the
third party of this use and in accordance with
the national legislation or practice in force. - In the case of income generated by the project
itself - General rule any income generated by the project
itself, including the sale of assets bought for
the project, are considered as income to the
project (receipts) - Derogation income generated by the use of the
knowledge resulting from the project is not
considered as a receipt
23Financing
- Reports and deliverables
- All reports and deliverables shall be submitted
within 45 days of the end of the period in
question. - The project is divided into reporting periods of
12 months for IP and NOE - For other instruments, reporting periods are
established on an ad hoc basis in the contract - P1 from month 1 to month X
- P2 from month X1 to month Y
- P3 from month Y1 to month Z
- final from month N1 to the last month of the
project
24Financing
- Reports and deliverables
- The consortium will submit the following reports
to the Commission - For each reporting period
- a periodic activity report
- a periodic management report
- a report on the distribution between contractors
- supplementary reports required by Annex to this
contract - an audit certificate when required
-
-
25Financing
- Reports and Deliverables
- In addition to the periodic reports of the last
period, for the last period - a final activity report
- a final management report
- supplementary reports required by Annex to this
contract - a report on the distribution between contractors
made after the end of the project of the
Community financial contribution - shall be 60
days after receipt of the final tranche
26Financing
- Audit certificates
- Article II.26
- each contractor shall provide an audit
certificate prepared and certified by an external
auditor (for public bodies - competent public
officer) - for each period for which an audit certificate is
required (article 7 - option 2) - every 12 months for IP/NoE (article 7 - option 1)
- where requesting a Community financial
contribution exceeding 750.000 for a specific
reporting period, even though an audit
certificate is not required for this specific
period
27Financing how ?
- Payment Modalities
- Periodic pre-financing (based on the applicable
periodicity) - The Community financial contribution is paid to
the coordinator on behalf of the contractors the
consortium decides on the allocation of each
tranche of its between the contractors
(consortium agreement)
28Financing
- Payment modalities
- The Community financial contribution shall be
paid in accordance with the provisions of Article
8 and II.28. Differences between - 1 one single reporting period
- 2 several reporting periods
- - with an audit certificate for each period
- - without an audit certificate for each period
- 3 one single reporting period - lump sum
29Payments and reporting schedule for an
IP(example of a 4 year contract)
Activity report
Reported costs
Activity report
Detailed work plan
Reported costs
Adjusted advance
Activity report
Detailed work plan
Reported costs
Adjusted advance
Activity report
Detailed work plan
Reported costs
Adjusted advance
Detailed work plan
Initial advance
0 6 12
18 24 30
36 42 48
Months
30Payments and reporting schedule for a STREP, CA
or SSA(example of a 3 year contract)
Final activity report
Final payment
Reported costs audit certificate (mandatory)
Intermediate pre-financing or payment NB
impact on the total pre-financing
Periodic activity report (mid-term review
optional)
Reported costs (audit certificate if required)
Detailed work plan
Initial advance
0 6 12 14
18 20 24 26 30
36 38
Months
31LIABILITY (1)
- New Collective responsibility of the contractors
- Mechanism by which a contractor may be held
liable, technically and/or financially, fully or
partially, for the action of another contractor - Why?
- Reinforce the protection of the financial
interests of the Community, both quantitative
(only pay what is due to be paid) and qualitative
(ensure that the project continues) - Consequence of FP6 principle of autonomy of the
consortium if the money is granted to the
consortium, which decides on its allocation, then
the consortium as a whole is to be held liable
32LIABILITY (2)
- Implementation applied as a last resort
- Breach of contract
- Depending on the nature of the breach, the
consortium will be invited to find the
appropriate solution (technical responsibility) - If no solution is found, the defaulting
contractor is excluded and the consortium is
requested to continue the project (technical
responsibility with financial consequences) - If the consortium refuses to perform
- 1 - the contract is terminated
- 2 - the consortium is requested to reimburse
money owed by the defaulting contractor
(collective financial responsibility)
33LIABILITY (3)
- Implementation limitations
- Limited in proportion to the participants share
of costs in the project, up to the total payment
they are entitled to receive - IOs, public bodies or entities guaranteed by
MS/AS solely responsible for their own debts - Exceptions for specific actions for SMEs,
fellowships, duly justified cases of specific
support actions - Without prejudice to civil and criminal actions
to be launched against the defaulting contractor
34LIABILITY (4)
- Additional impacts
- Raises awareness among contractors
- 1 - constitution of the consortium
- 2 - projects with real and lasting common
interests (avoid artificial transnational
projects) - 3 - establishment of internal auto-controls and
checks and balances within the consortium - Limits systematic requests for bank guarantees
and performance of ex-ante financial controls - 1 - as foreseen in the new financial regulations
- 2 - depending on the impact of the limitations
(risk assessment - to be detailed in Guidelines
on negotiations)
35Controls (1)
reinforce scientific monitoring and ex-post
financial controls Simplified and streamlined
ex-ante controls due to the collective
responsibility Simplified and streamlined
day-to-day financial management due to the audit
certificates and the new approach on eligible
costs (no more formal conformity with cost
categories) Reorient resources in qualitative
monitoring and control 1 - assessment of the
scientific outputs 2 - appraisal of the necessity
of the costs with regards to these outputs
36Controls (2)
- How?
- New continuous monitoring by Commission with
external experts (mandatory for IP and NoE),
based on simplified procedures (no public
procurement) - Newperiodical reviews of results achieved and
expenditure made - go/no-go procedure (12 months
basis for IP NoE - ad hoc for other
instruments) - Technical (incl. ethical), technological, and
financial audits
37Sanctions
- Autonomy implies accountability
- New in case of irregularity in a contract...
- 1 - exclusion from the contract
- 2 - exclusion from OTHER FP6 contracts, and from
other Community policies - 3 - ineligible to participate in FP6 activities,
and from other Community policies - New liquidated damages in case of financial
overstatement - Without prejudice to civil and criminal sanctions
38Intellectual Property Rights (IPR)
- Developed on the basis of
- Feedback from FP5
- Features of the new instruments
- contractors may leave/join during the project
- larger projects
39Principles
- Consistency with FP5 (similar concepts)
- Simplification
- ? New Same IPR rules for ? all instruments
(fewer exceptions) - ? New Same IPR rules for all contractors
- Increased certainty, in particular regarding
access rights (restricted to what is necessary) - Increased emphasis on the management of knowledge
and IP (especially new instruments)
40General Concepts
- Definitions no major change compared to FP5
- knowledge, pre-existing know-how, use,
dissemination, ... - Ownership no major changes compared to FP5
- resides with the contractor (incl. JRC)
generating knowledge - exception for SME actions cooperative research
- SMEs own results not the RTD Performers - collective research - SME associations own
results - transfer of ownership prior notice to other
participants Commission (possible objection
within 30 days) - public procurement (Commission owns results)
41General Concepts -
- Protection
- Where there is commercial application and subject
to legitimate interests, it is a requirement to
protect - Where there is no protection, Commission may
protect - Publication
- allowed if not detrimental to protection
- prior notice to Commission other contractors
(possible objection within 30 days) - Use / dissemination
- Obligation to use and disseminate
- Commission may disseminate itself if needed
42Access Rights
- General principles
- New Granted on written request, access rights for
use of anothers results only where necessary
(not by right) - No sub-licensing (unless explicitly agreed
possible optional clause for software) - Obligatory Access Rights between contractors
limited to what they really need (either for
carrying out the project or for using their own
knowledge) but broader Access Rights may be
freely negotiated - Access Rights granted to third parties
Commission may object
43Access Rights
- New features
- Feedback from FP5 need for pre-existing know-how
(Pre-Existing Know How ) to be better safeguarded - New Possibility for a contractor to exclude
specific Pre-Existing Know How from the
obligation to grant Access Rights to the others - with the agreement of all participants
- before the contractor concerned signs the
contract (or before entry of a new contractor)
44FP6 System of Access Rights
Access rights to
Access rights to
pre-existing know-how
knowledge
If a contractor needs them for carrying out its
own work under the project
For carrying out the project
Royalty-free unless otherwise agreed before
signing the contract
Royalty-free
If a contractor needs them for using its own
knowledge
For use (exploitation further research)
Non-discriminatory conditions to be agreed
Royalty-free unless otherwise agreed before
signing the contract
Possibility for participants to agree on
exclusion of specific pre-existing know-how
before signature of the contract (or before
entry of a new participant)
45Consortium Agreement
- WHY ? (1)
- 1 - Mandatory unless excluded by the call for
proposals - 2 - Management of the consortium
- distribution of funds paid to the consortium (via
the coordinator) - no automatic pre-allocation of the funds among
contractors to be decided by the consortium - evolution of the work programme
- organisation of work to be carried out
(sub-projects) - reports presented and submitted by the consortium
(via the coordinator) - evolution of the consortiums composition
(modification)
46Consortium Agreement
- WHY ? (2)
- 3 - IPR issues should be agreed before signature
of the contract (mandatory for specific
Pre-Existing Know How exclusion) - 4 - Global Risk Management collective
responsibility - technical implementation of the action
collective responsibility of the contractors - consortium to deal with breach of contract /
non-performance and imposition of financial
collective responsibility and any financial
security necessary for same
47Consortium Agreement
- Issues
- Decision-making process
- governance may range from 1 participant, 1
vote to elective dictatorship, via the
shareholder approach - IPR
- - ensure that agreements necessary for the
implementation of the project have been reached -
exclusion of background/sideground - - initiate common strategy on dissemination/use/p
rotection search for industrial partners - Global Risk Management
- - establish internal auto-control and a checks
and balances mechanism (periodic distribution of
the funds, progress reporting, etc). - - specific issues regarding competitive calls,
costs less than EC funding etc for specific
instruments
